Building the Mini Dome

by joshpit2003 in Outside > Backyard

42 Views, 0 Favorites, 0 Comments

Building the Mini Dome


I designed and built this 308-sq-ft accessory structure in the backyard of my Portland, Oregon home.

Its a super-insulated mini geodesic dome and the world's first pentakis dodecahedron home. The unique shape allows every triangle to be identical in shape, size, dihedral angles, and strut lengths.

Build cost: ~3,100 hours and ~$100,000 USD (including all fees, materials, and furnishings).

Website: DodecaDomes.com

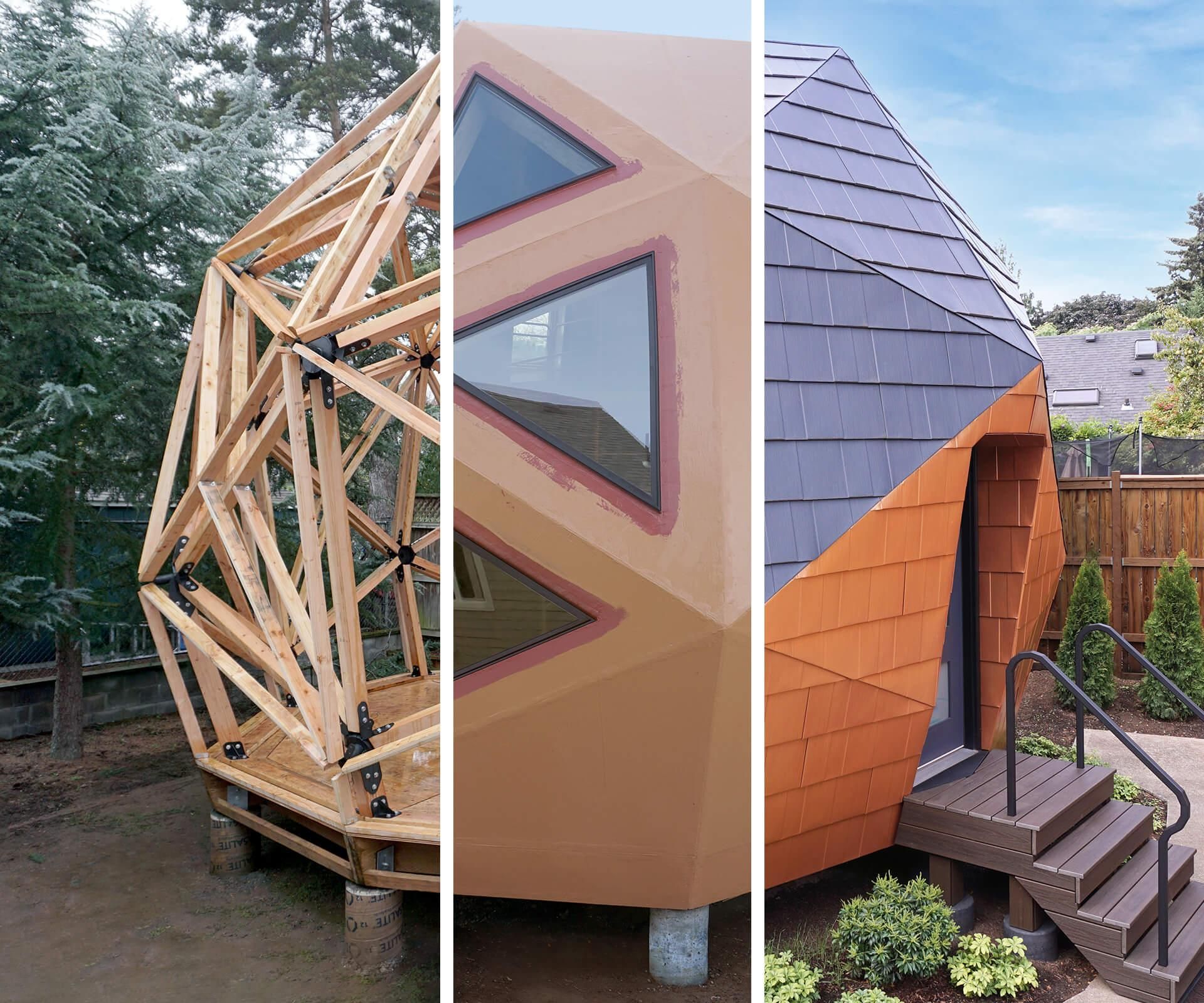

The following is a brief overview of the construction process.

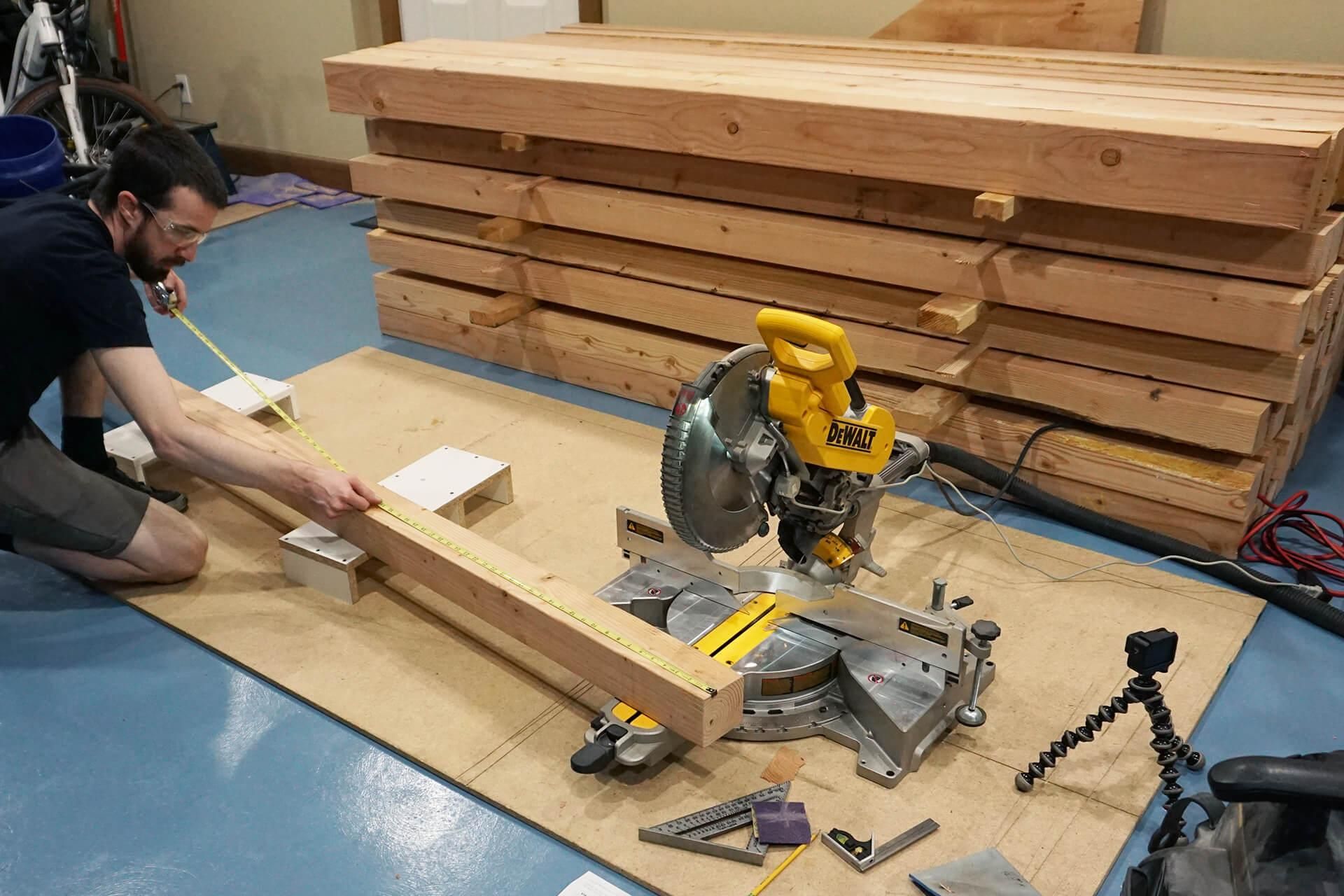

Prefab


Prefabricate the struts, panels, floor framing, room framing, and rebar cages.

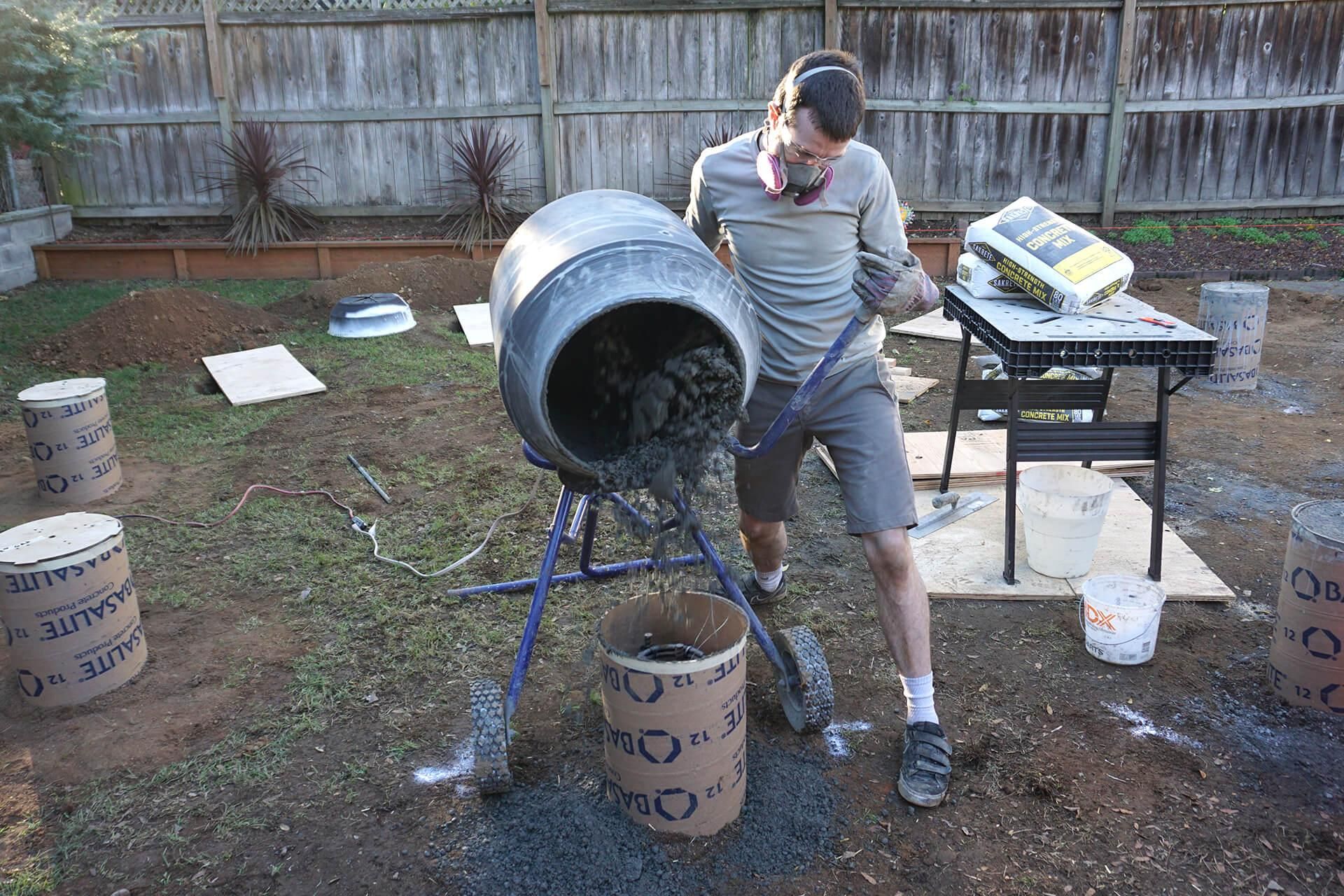

Foundation


Dig the holes and pour the concrete piers.

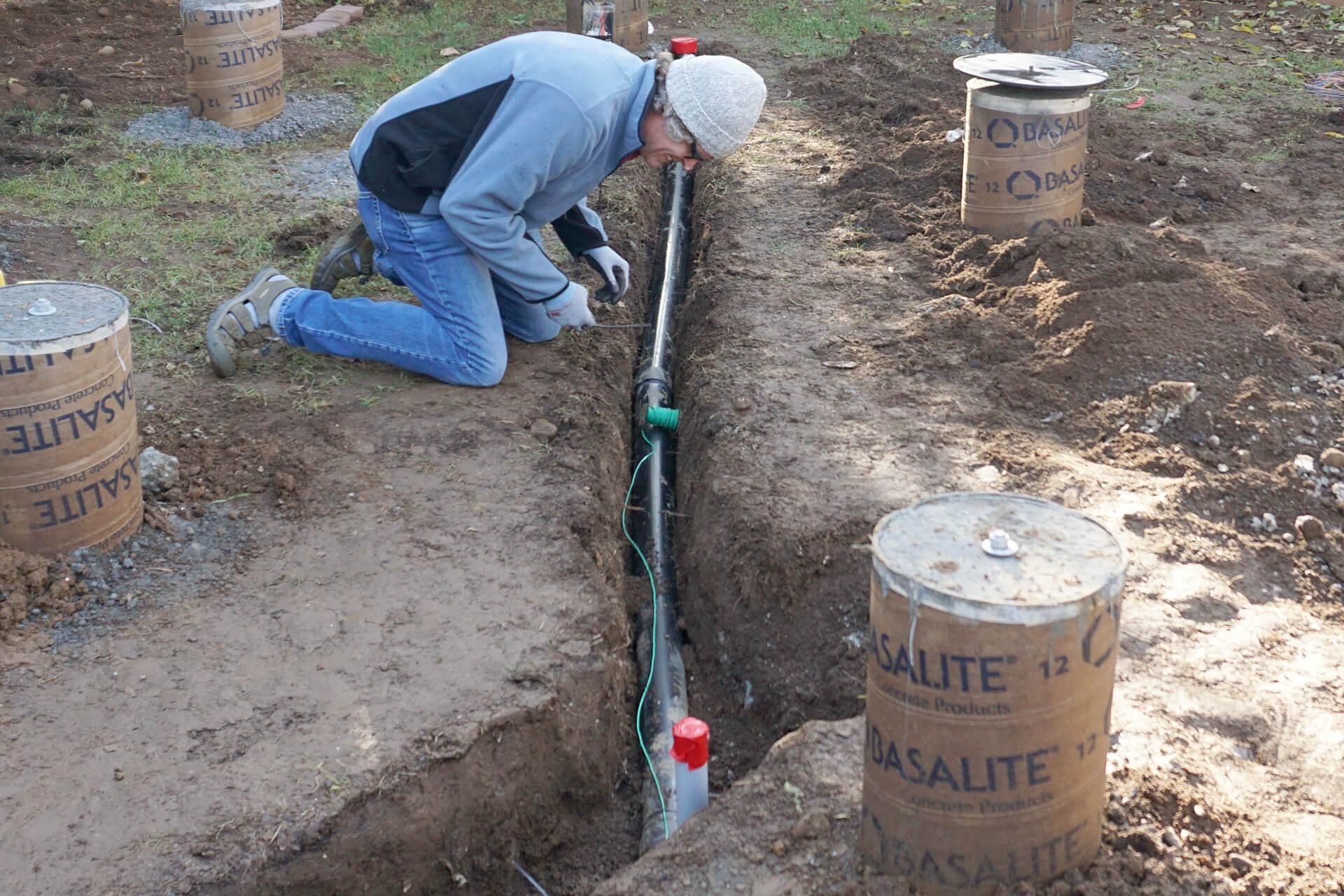

Utilities


Trench and run the sewer, water, electrical, and data conduit to the stub-out locations.

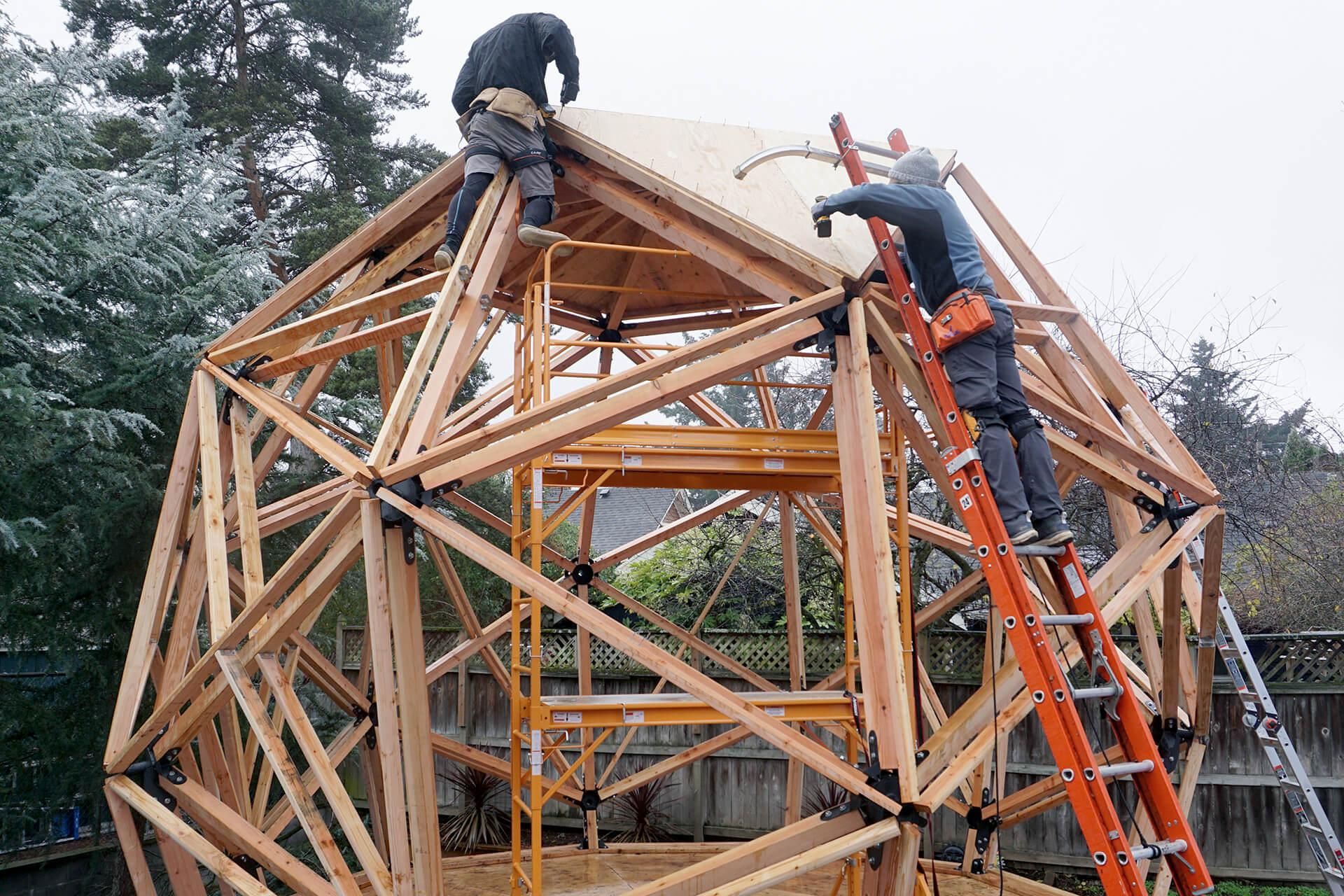

Framing


Frame the floor, inner wall, outer wall, and install the sheathing.

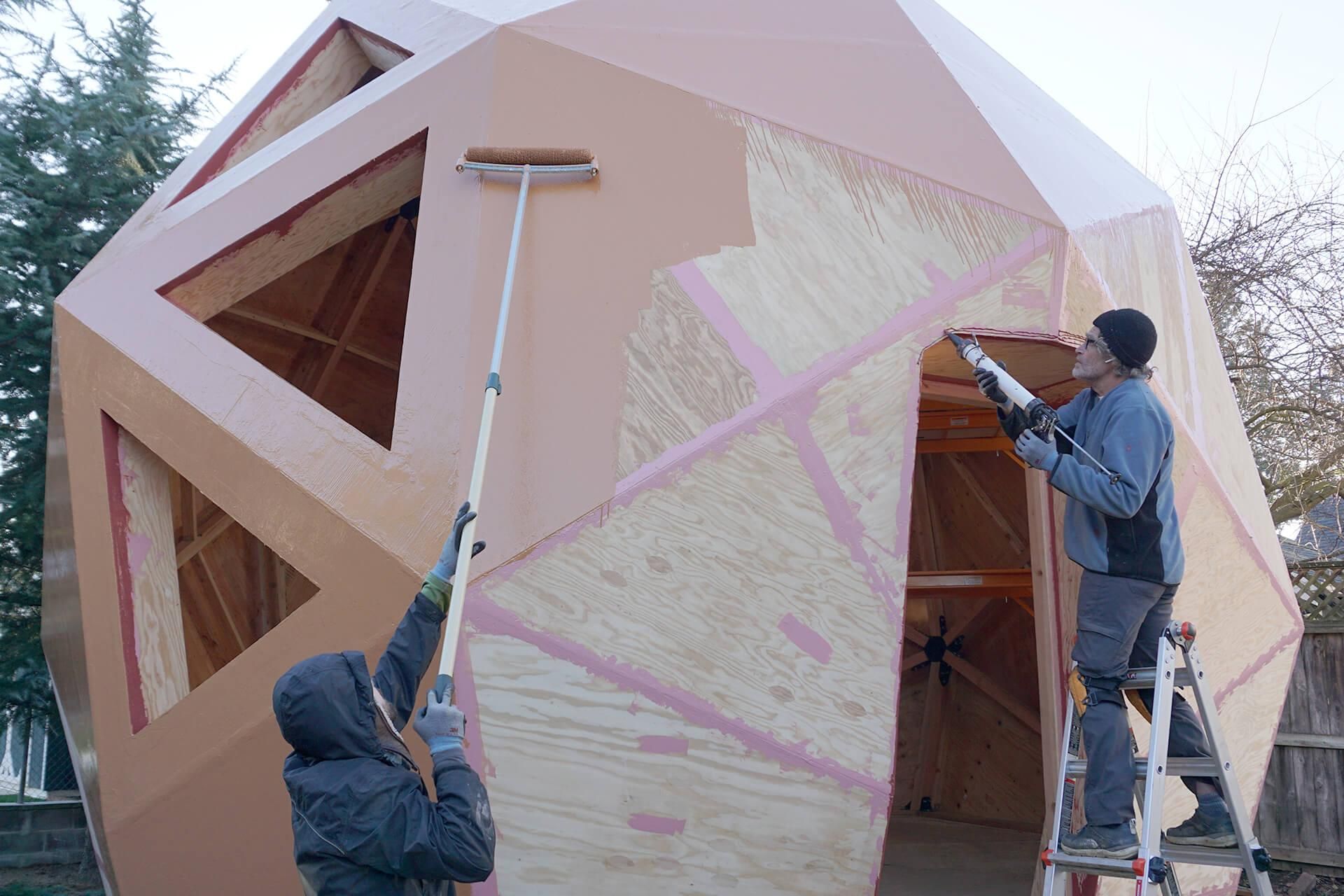

Sealing


Apply an underlayment, install the windows, cover the crawlspace, and install the front door.

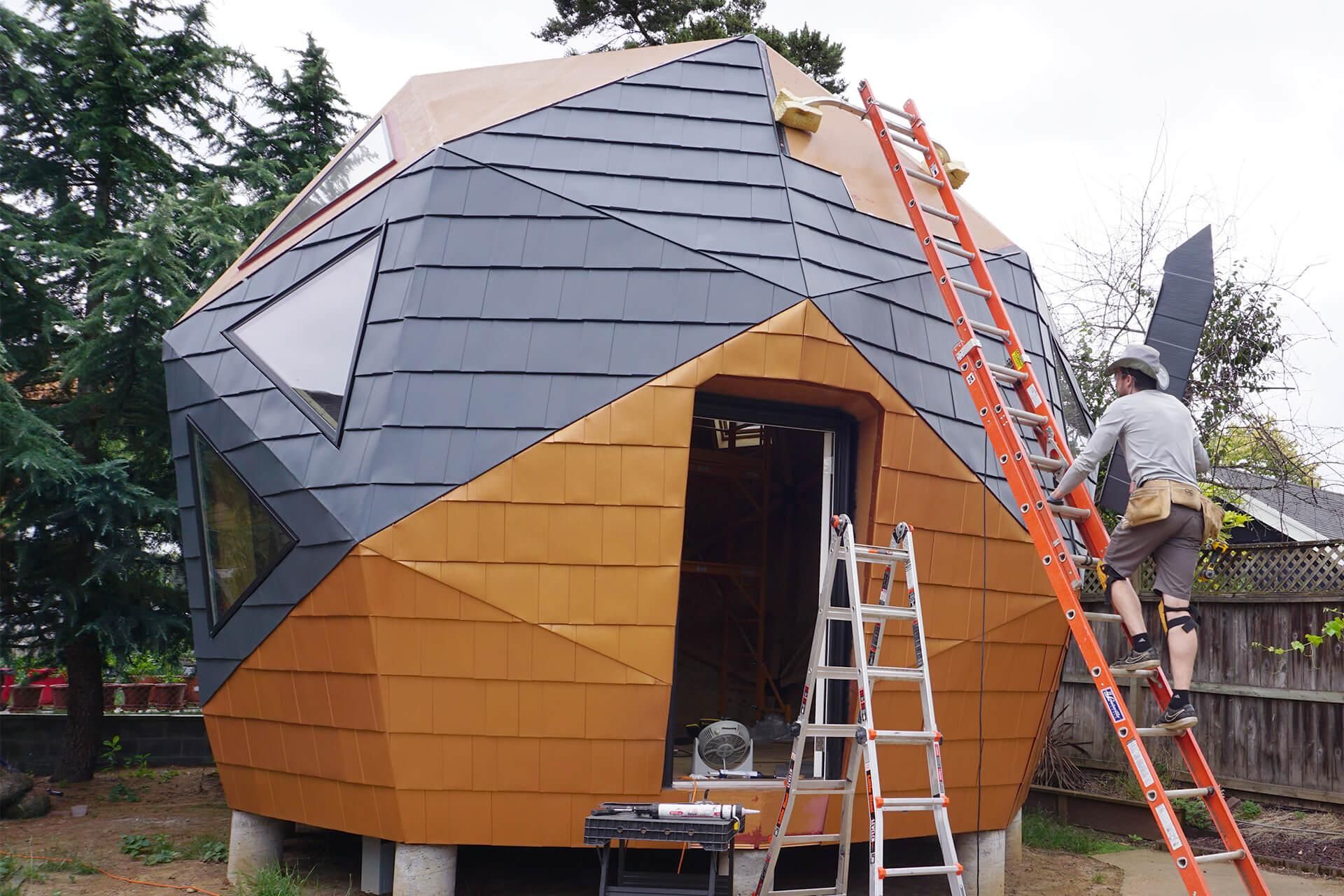

Roofing


Install roof joist supports and paint the door frame. Cut and install the metal shingles, the flashing, and the vents.

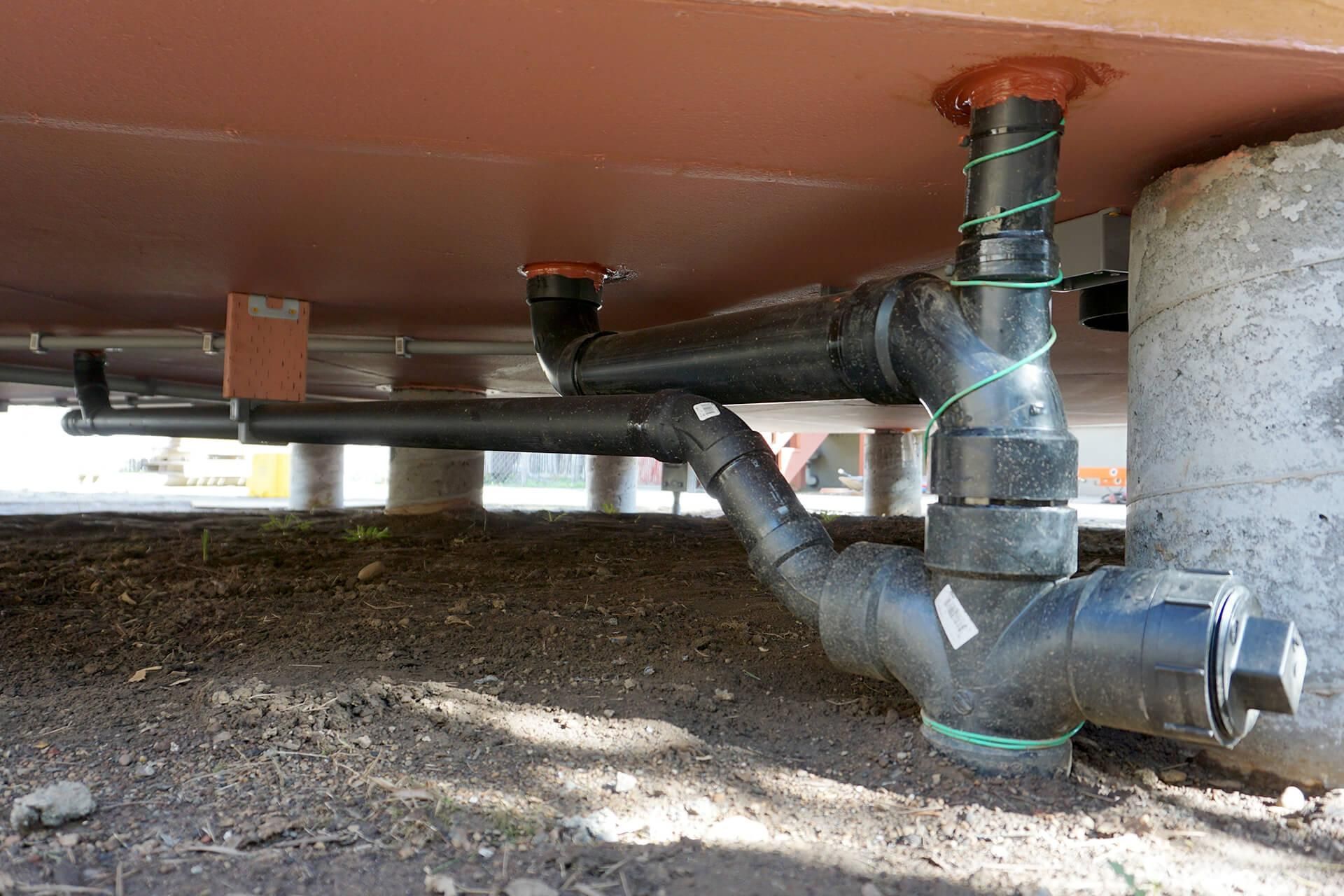

Underfloor


Install the window weep tubes, HVAC ducts, waste pipes, water conduit, data conduit, electrical conduit, utility closet drain, and thermostat conduit.

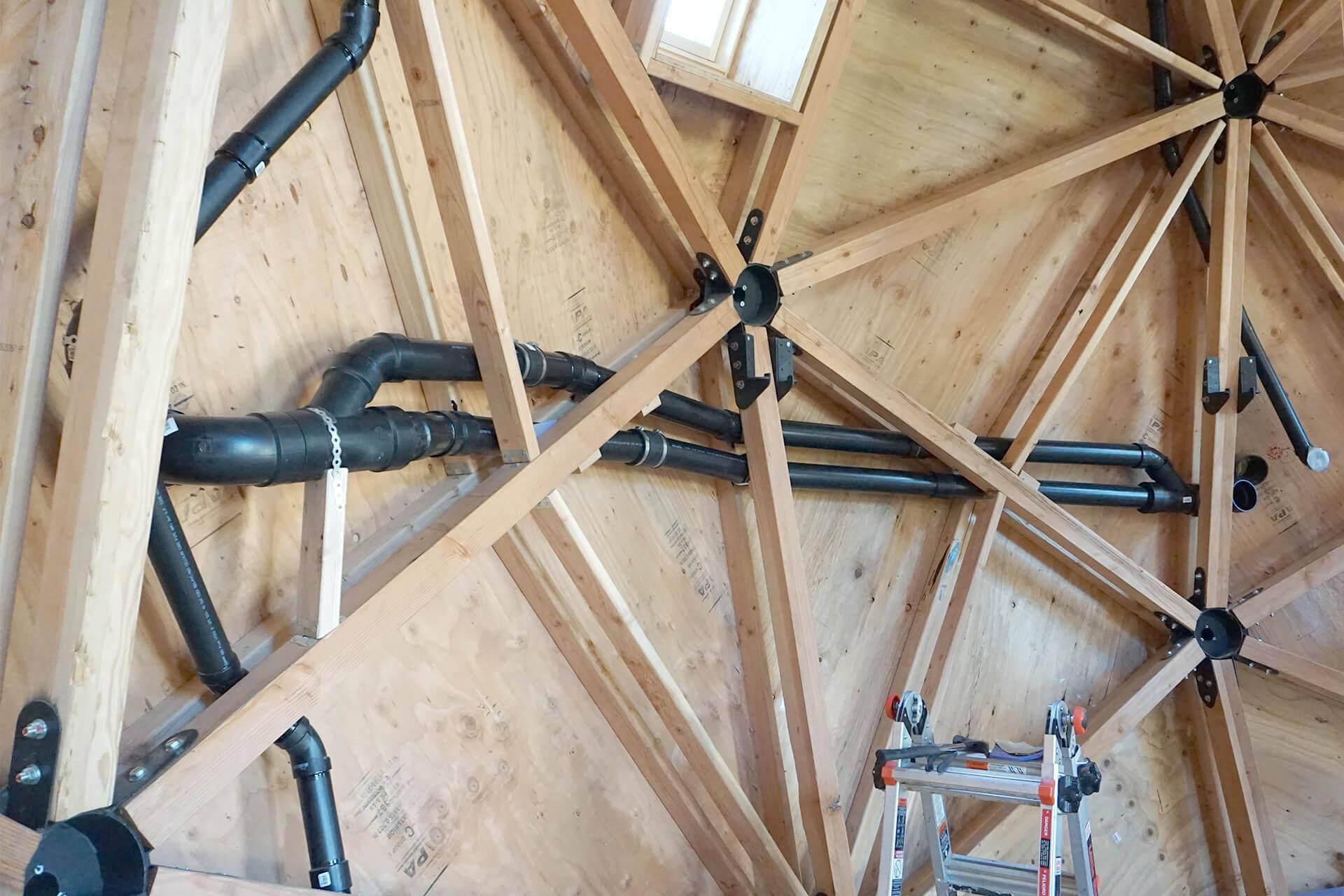

In-Wall


Install the window blocking, support column, brackets, vent pipes, door wall, and HRV ducts. Re-torque all connections and apply a wood treatment.

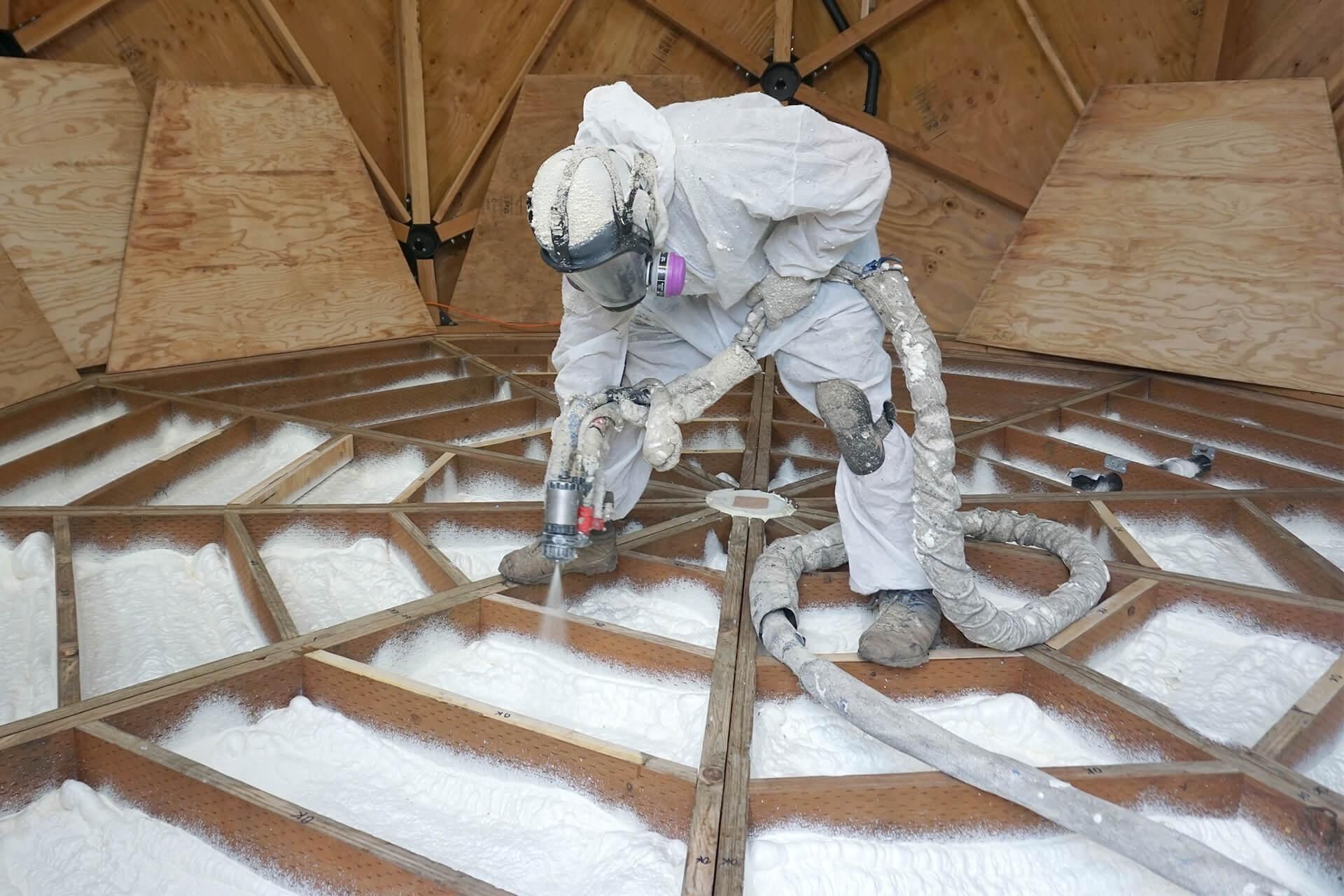

Spray Foam


Have the dome sprayed with closed cell, 2lb, high lift, HFO blower, low VOC, polyurethane foam. Cured SPF is inert, odorless, and does not off gas.

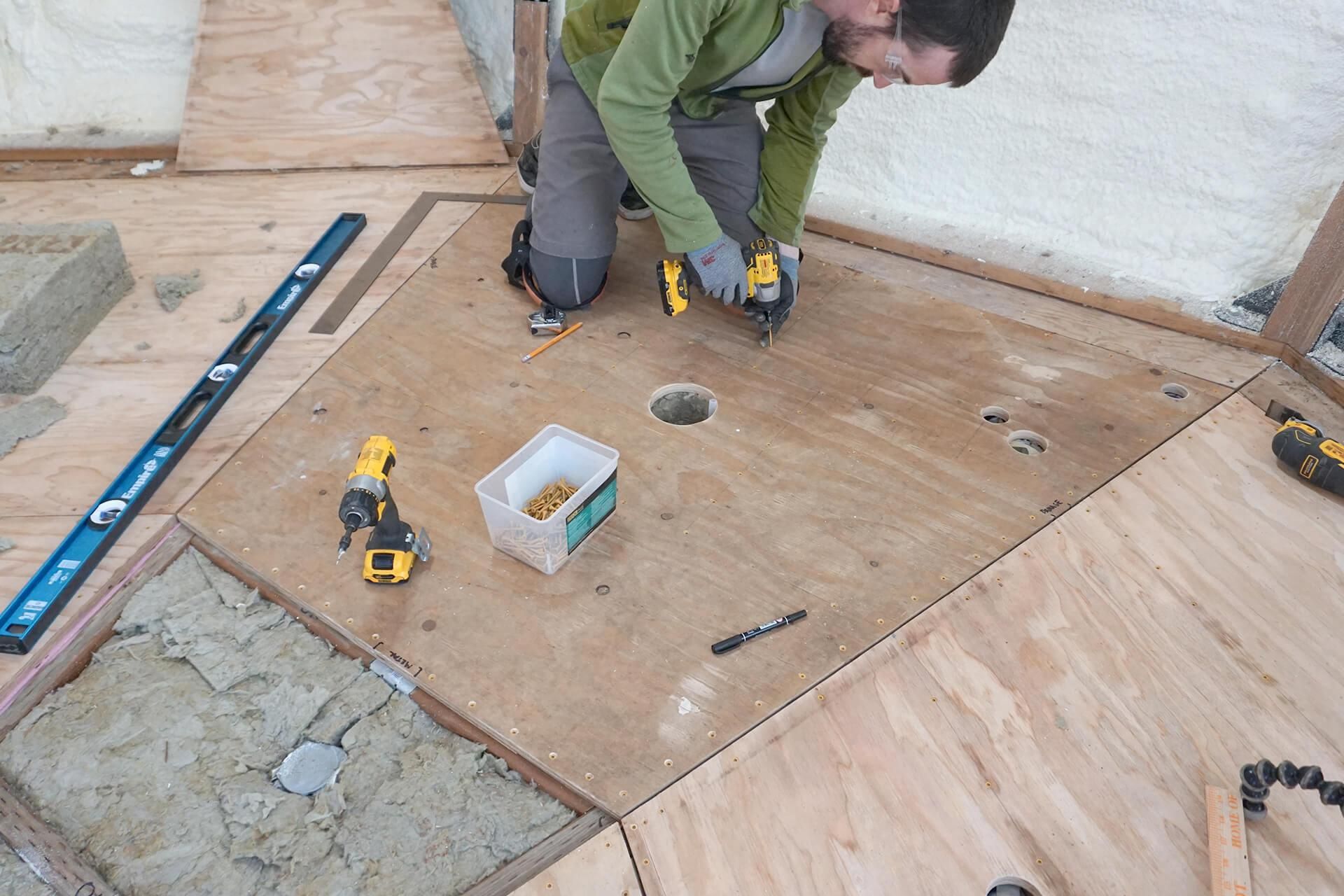

Subfloor


Seal the floor beams, cut and install mineral wool, and screw down the subfloor.

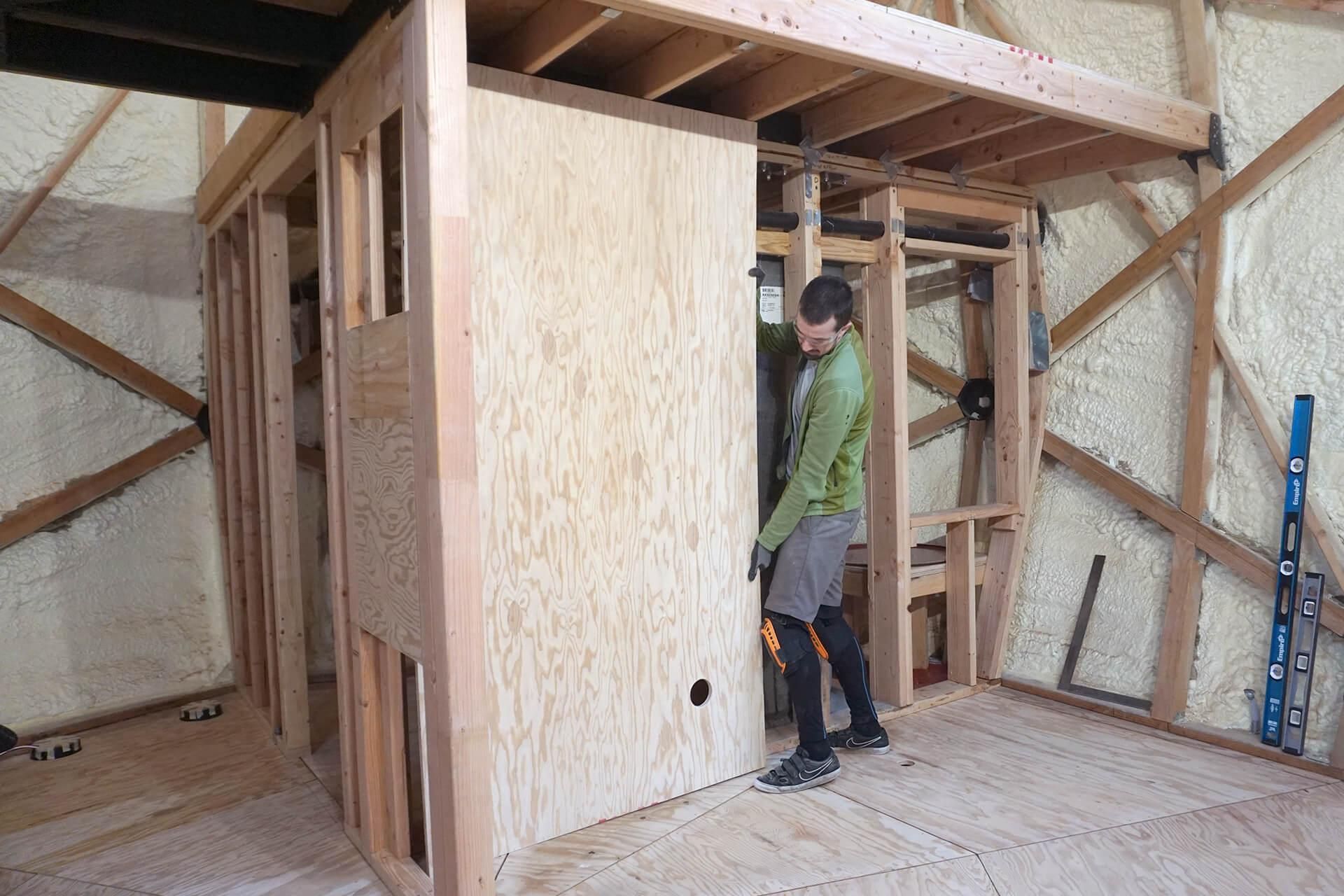

Room Framing


Erect the interior walls, plumb the vent pipe, frame the upper floor, install the shower, build the water heater shelf, and install the upper subfloor.

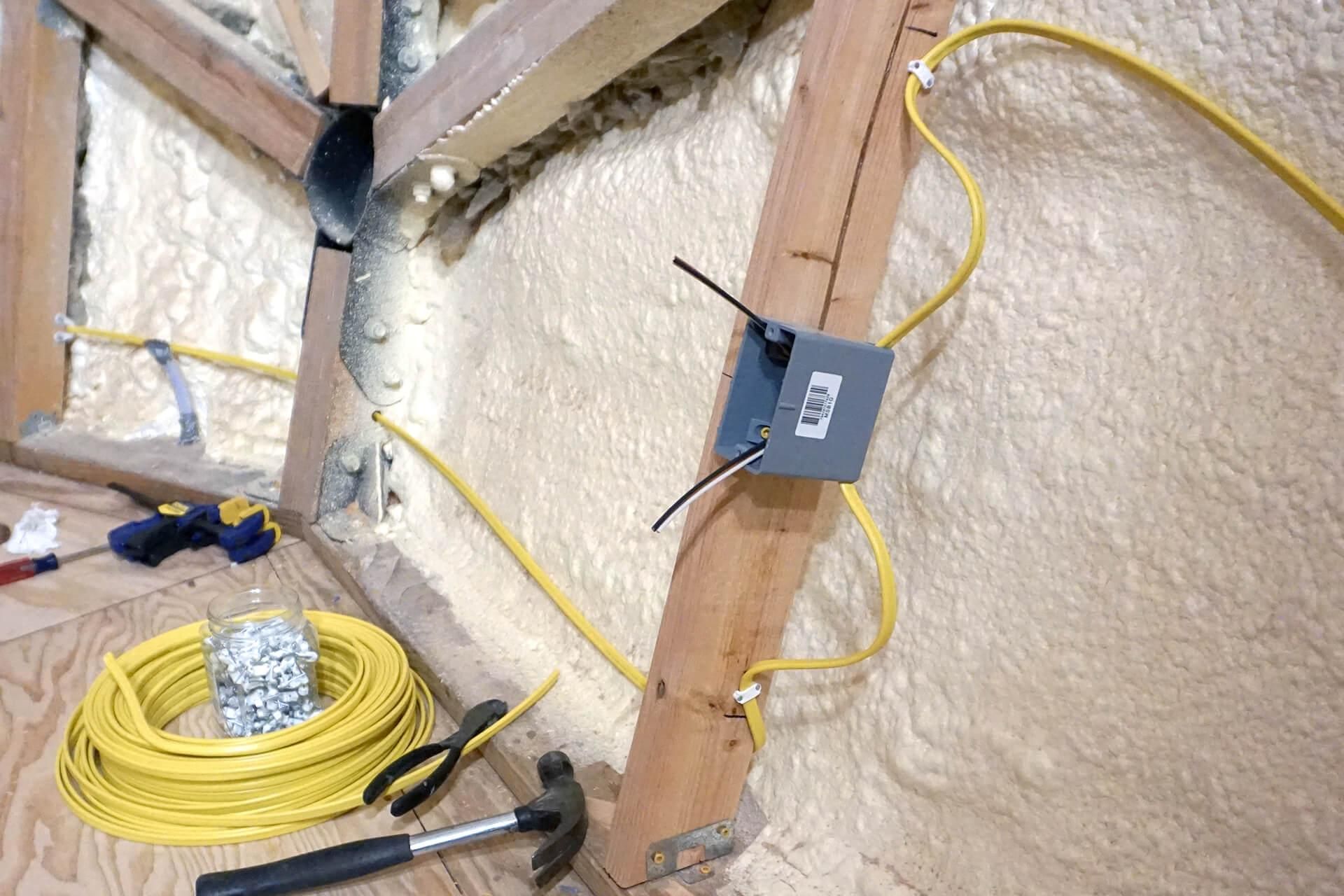

Electrical


Install the panel, HRV unit, and electrical boxes. Wire the feeder and branch circuits.

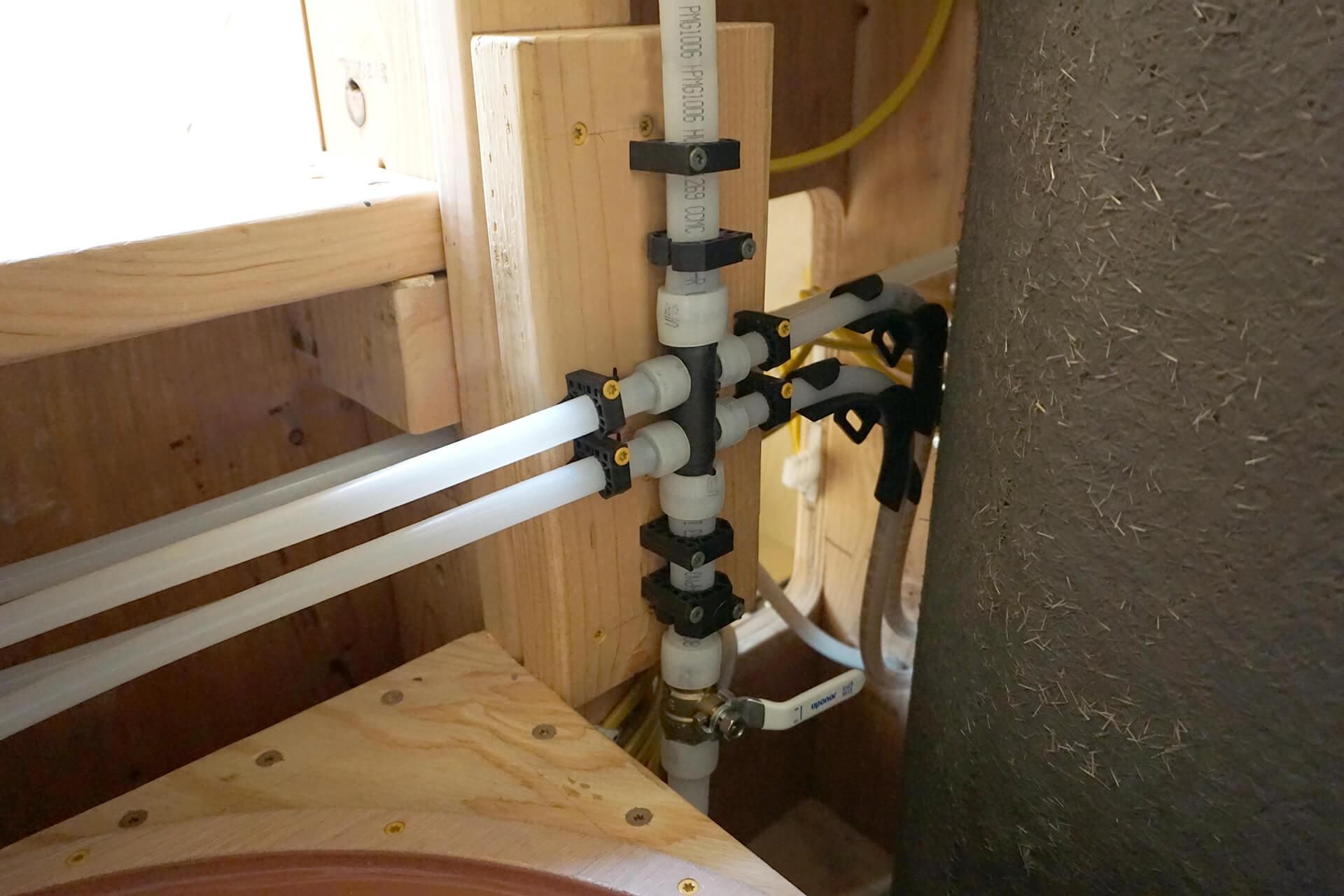

Plumbing


Run tubing to all fixtures, install the water heater, and connect to the water supply.

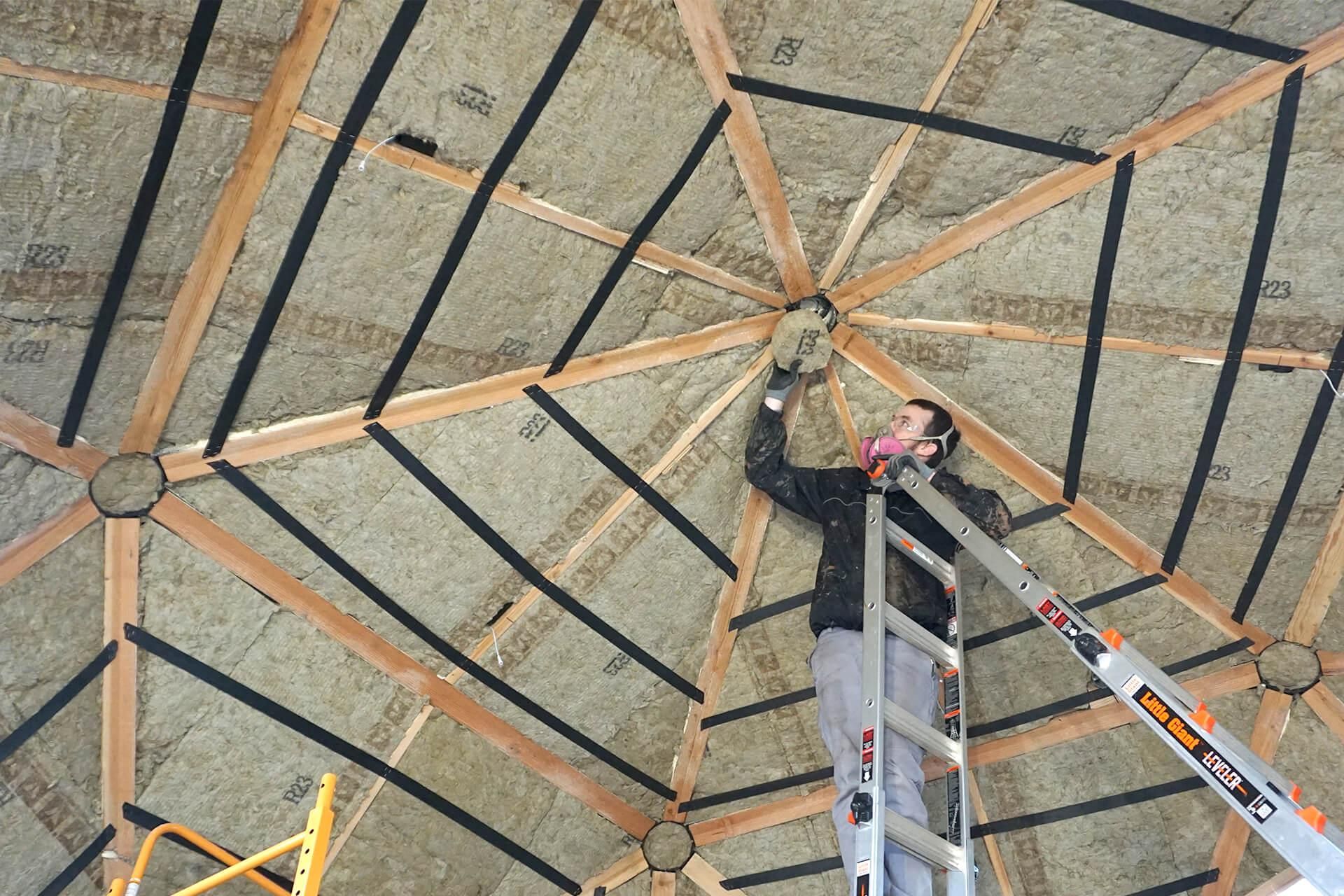

Soft Insulation


Cut and secure the mineral wool into the walls.

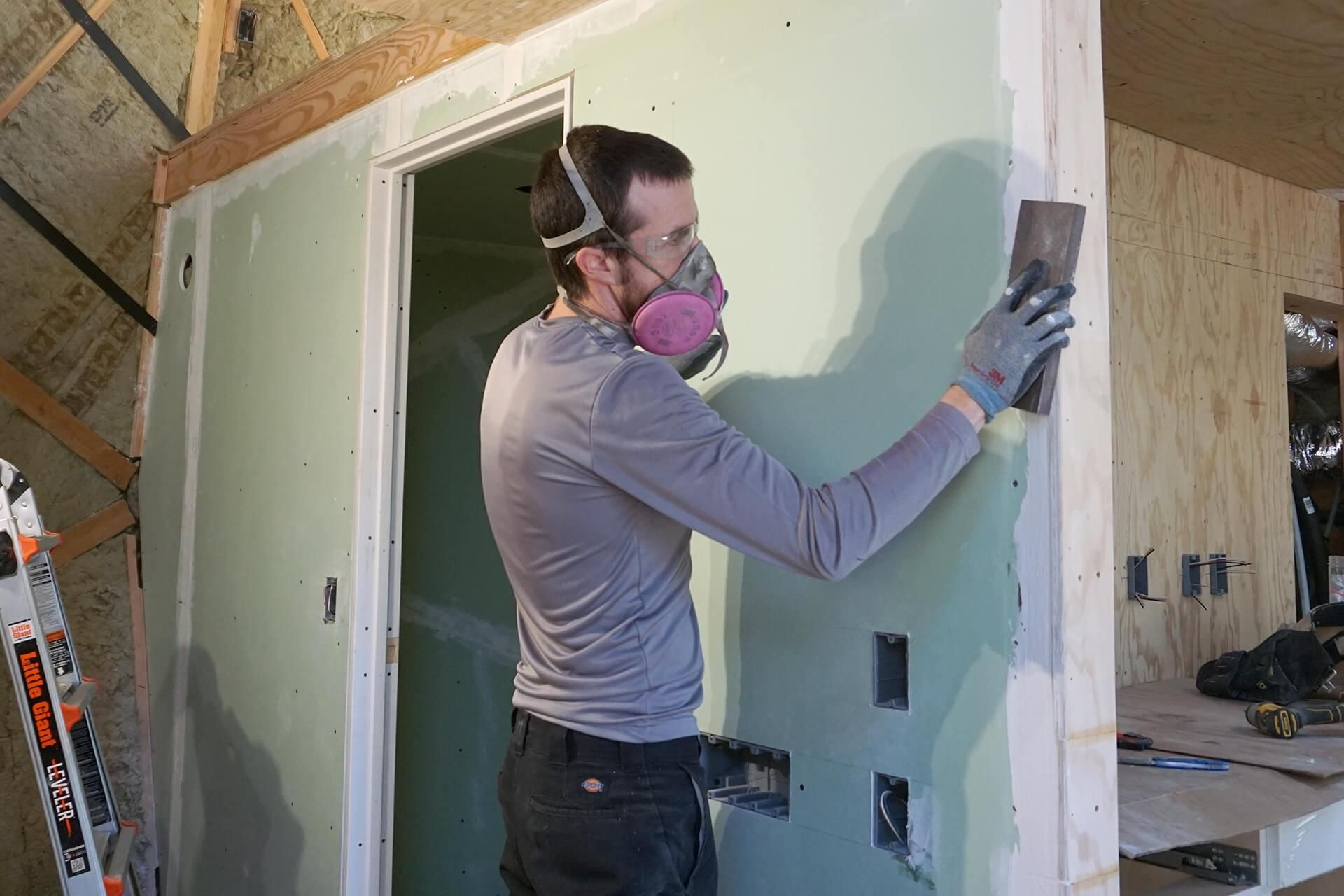

Drywall


Install blocking, hang the bathroom door, install plywood panels, cut and hang drywall, apply and smooth drywall mud, and primer the walls.

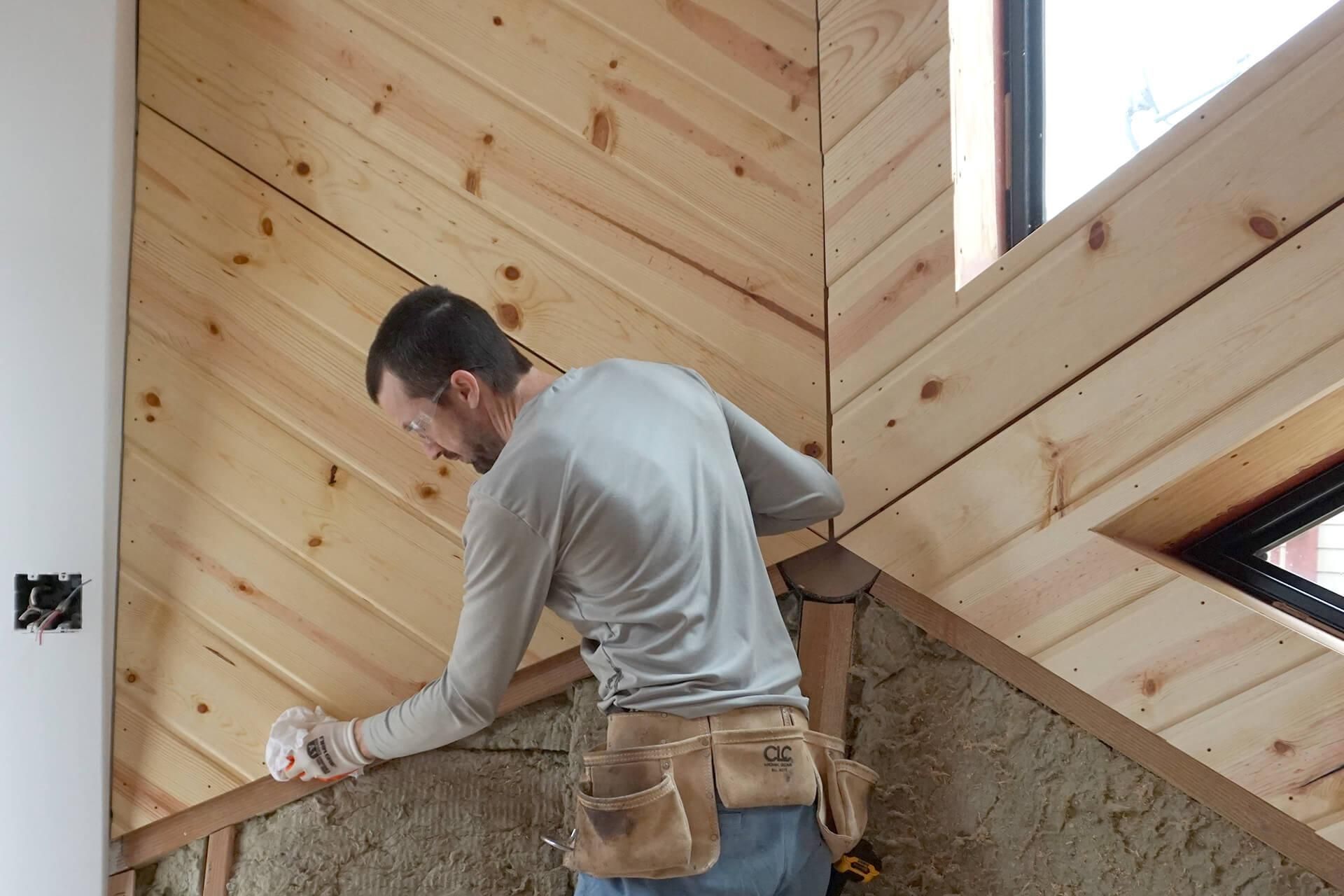

Wood Paneling


Sort planks, create a cutting jig, cut panels, mark screw locations, apply a wood finish, and install the panels.

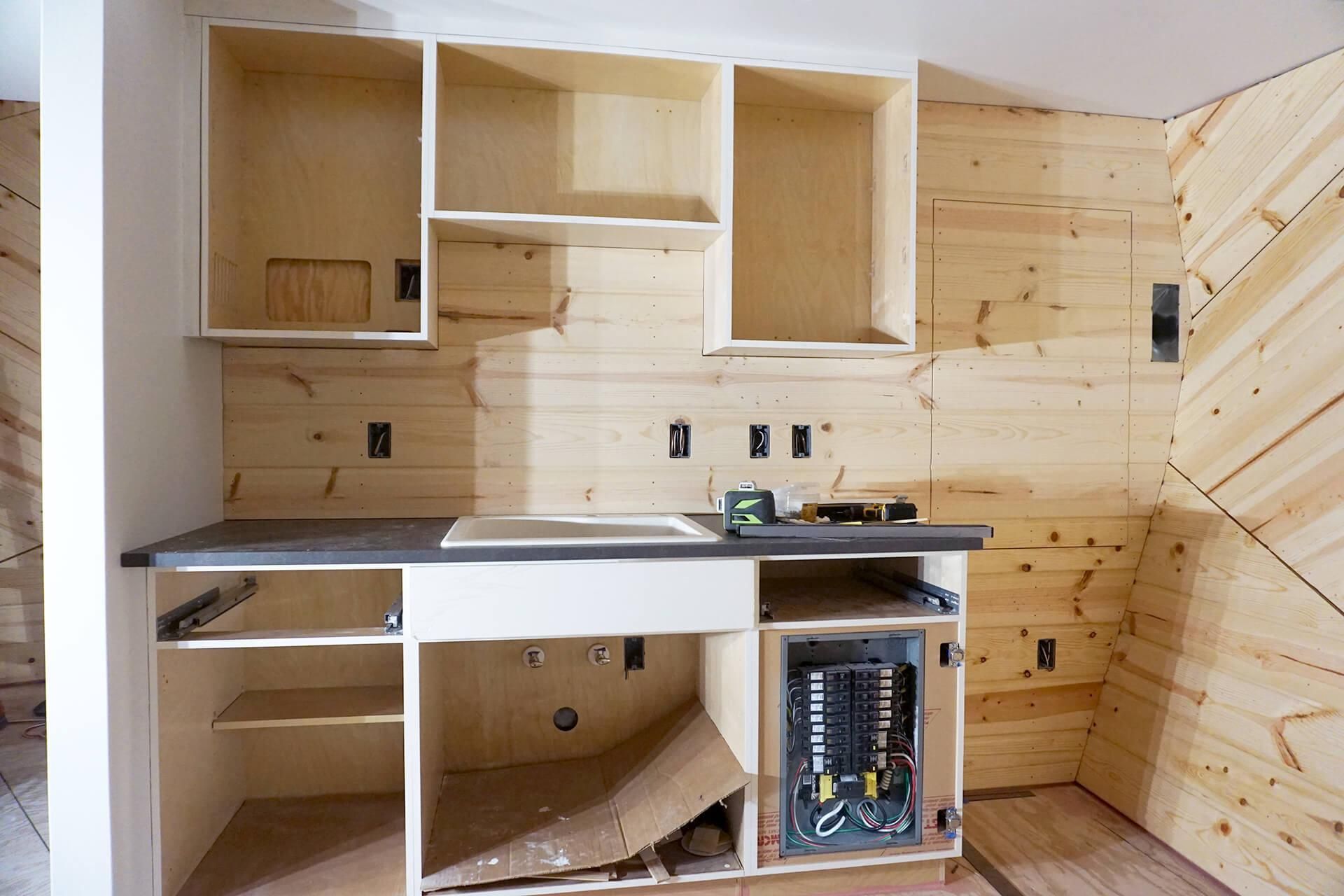

Kitchenette


Hang the upper cabinets, secure the countertop, install the sink, fit the utility doors, and panel the backsplash.

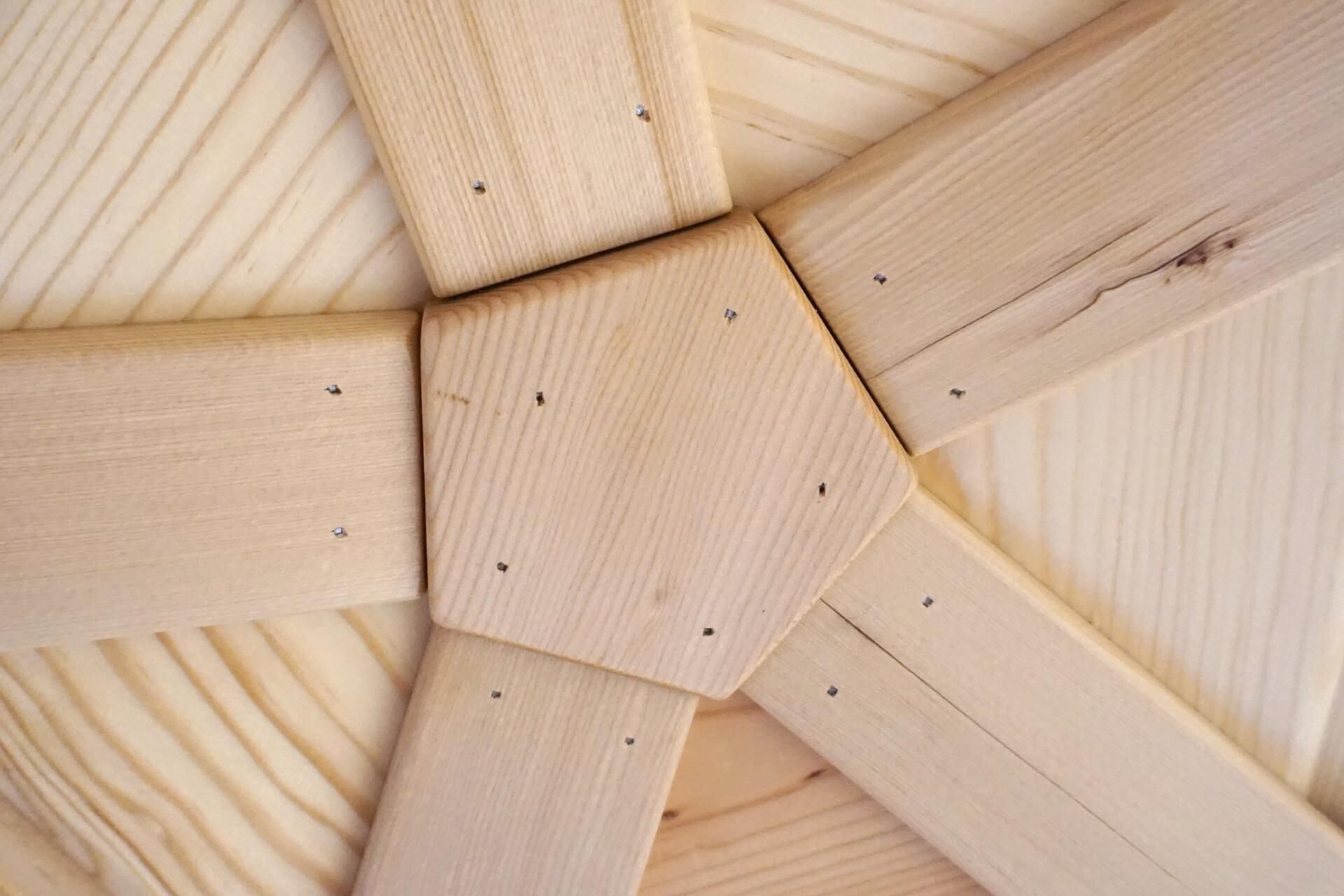

Panel Trim


Fill exposed fasteners with wood putty. Cut, finish, and install the trim pucks and trim straights.

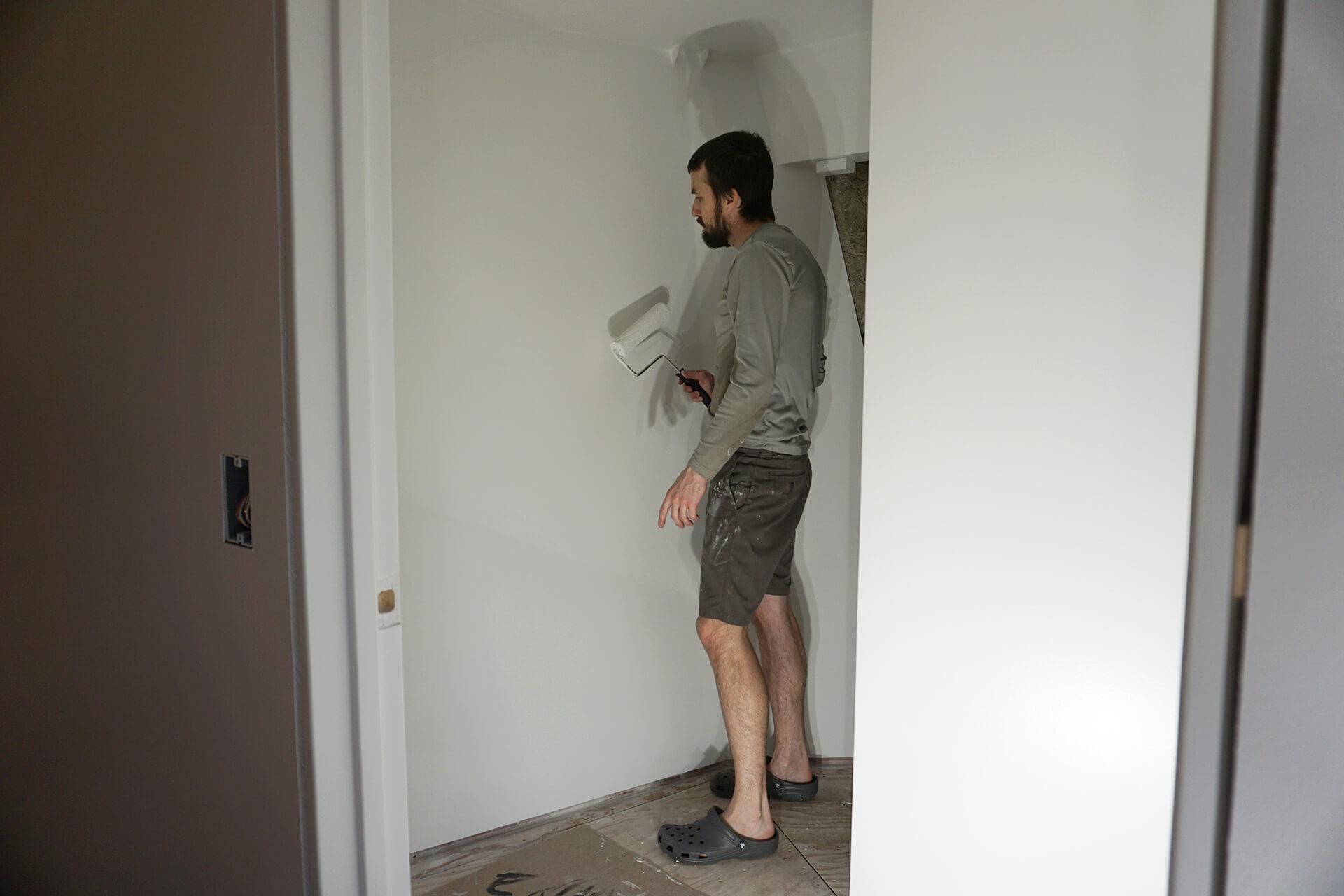

Painting


Caulk the shower and inside corners. Paint the bathroom door, utility door, walls, and front door.

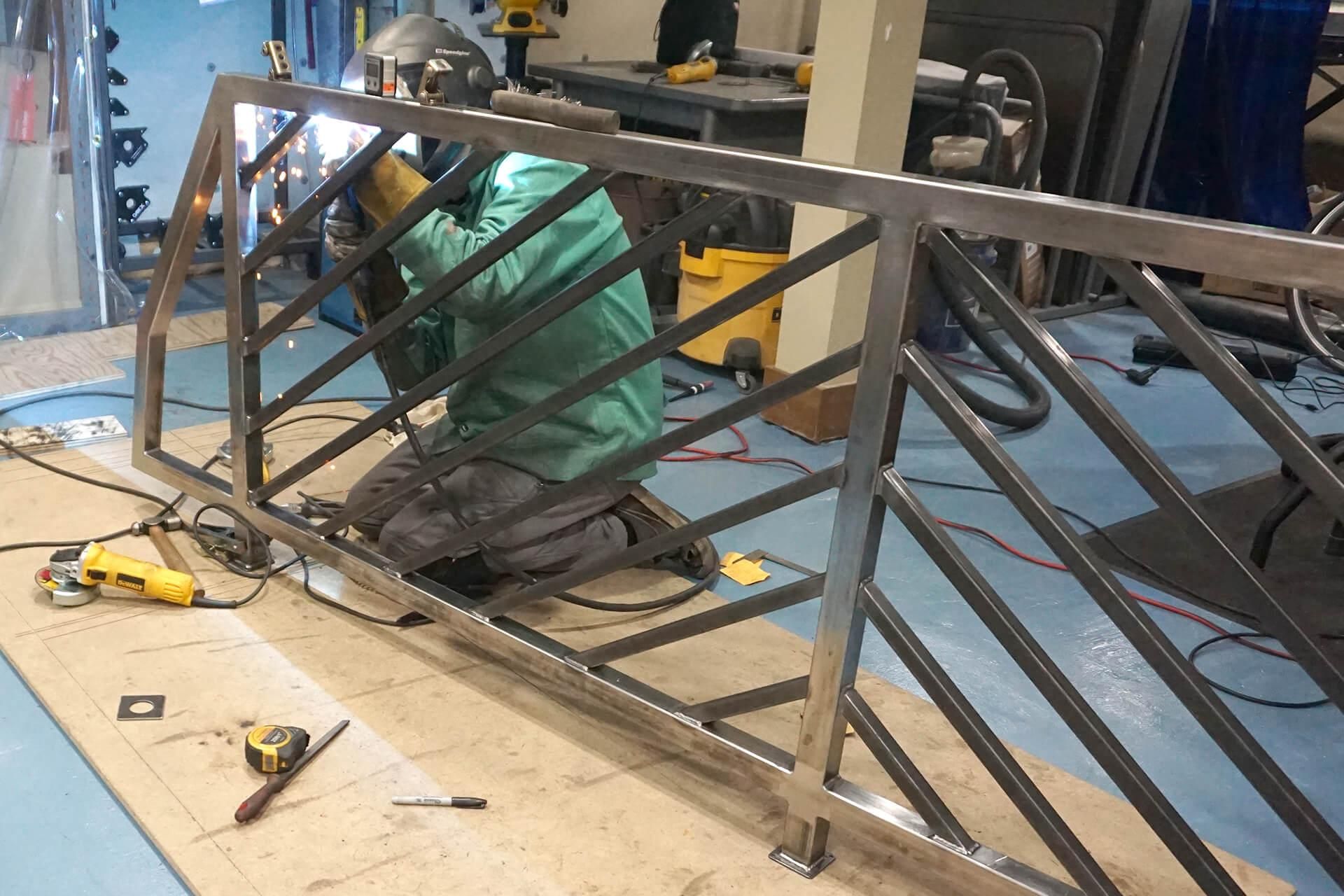

Metalwork


Cut, weld, and grind the metal pieces. Have them powder coated.

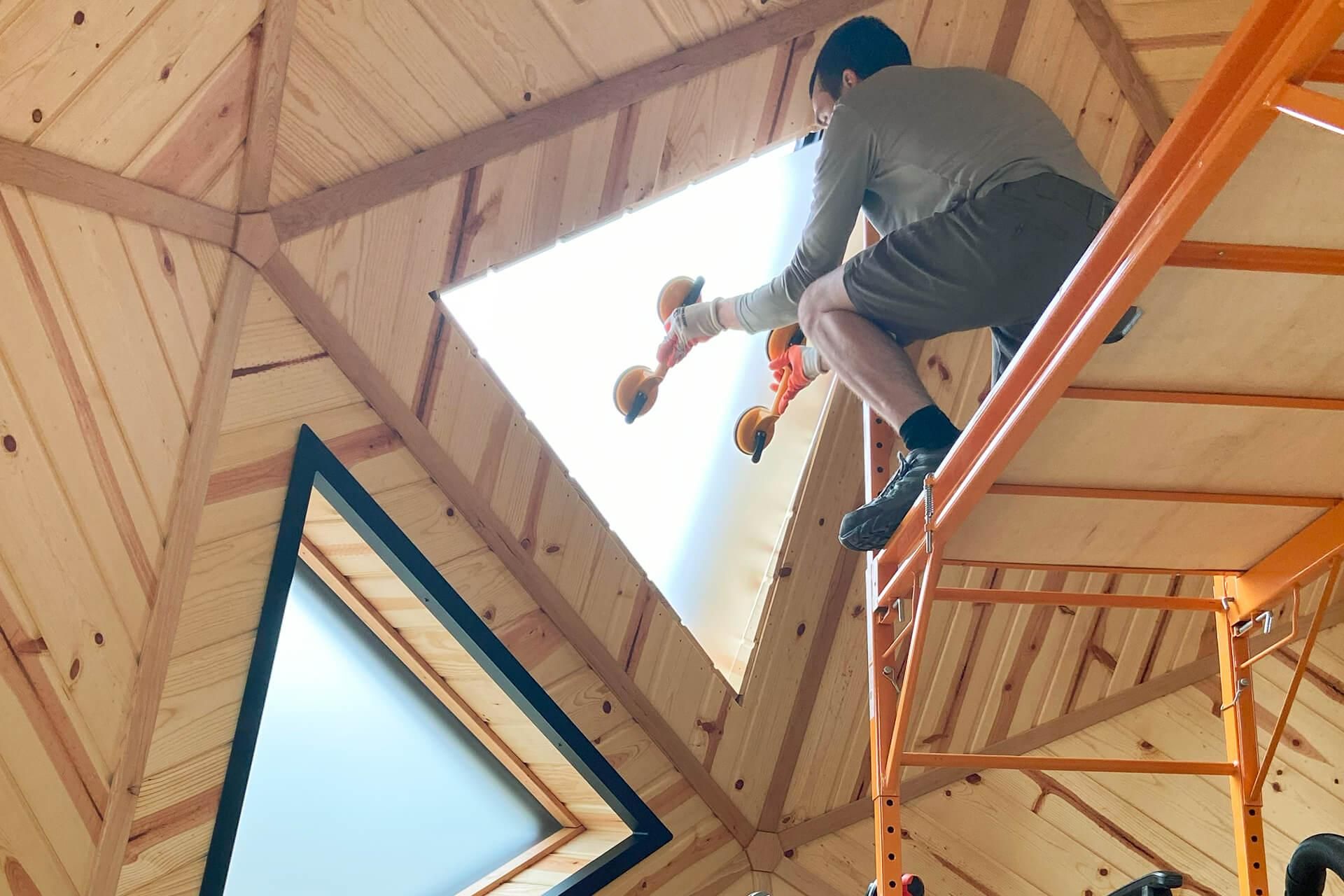

Acrylic


Cut and install the wooden trim, install the frosted acrylic, and install the metal window buck trim.

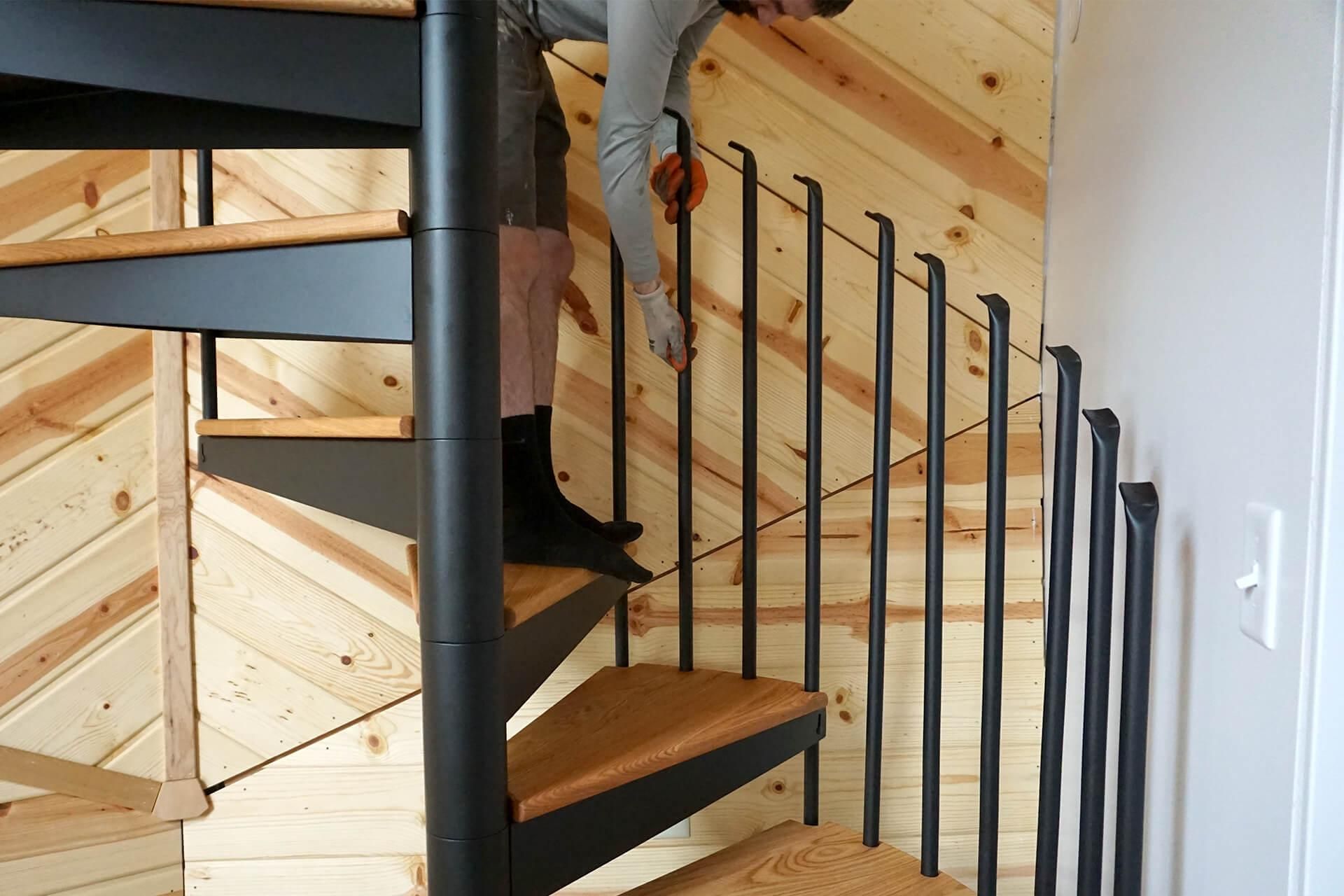

Spiral Staircase


Install the spiral staircase and railings.

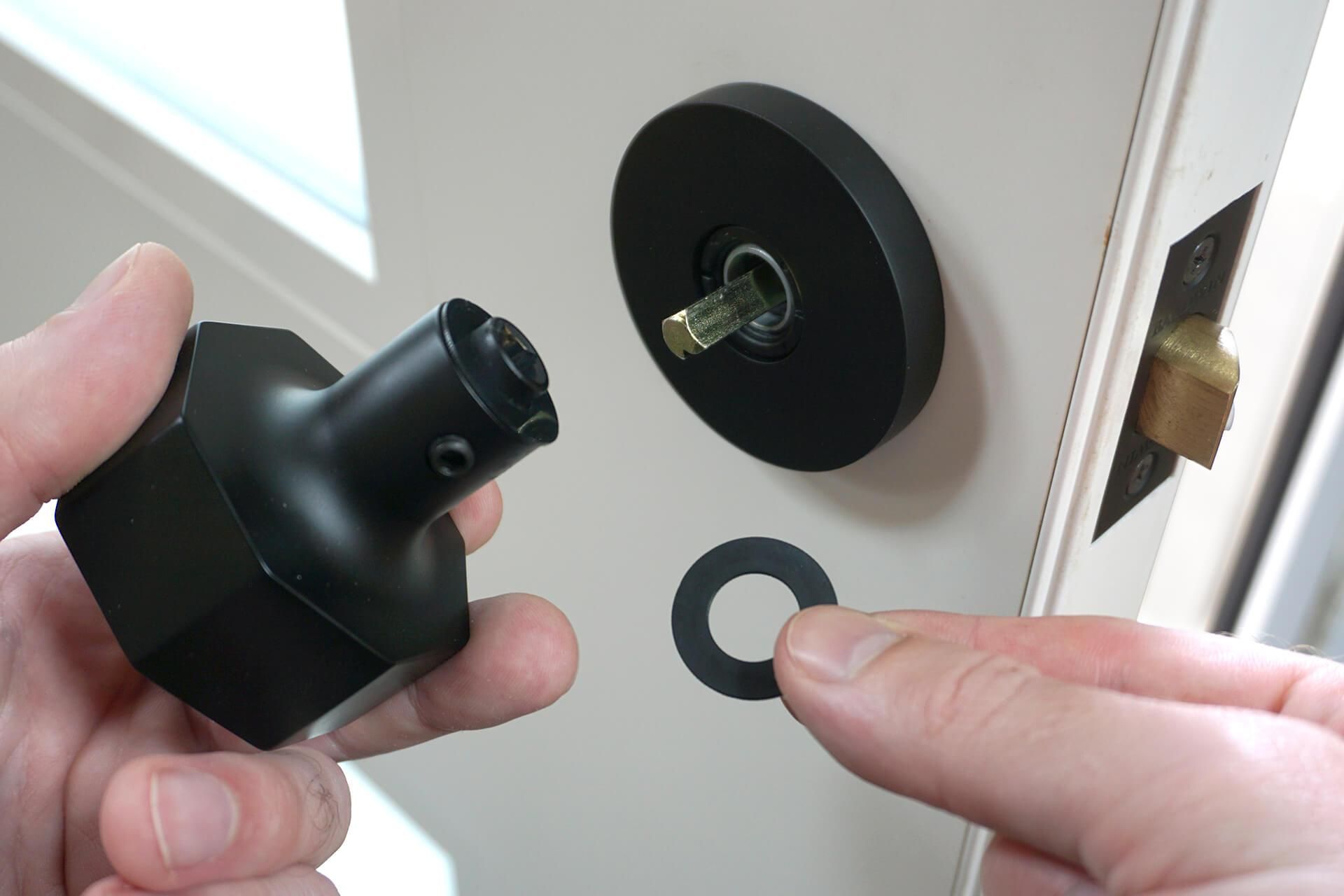

Finishing


Finish the electrical, plumbing, doors, vanity, cabinets, utility closet, and bathroom.

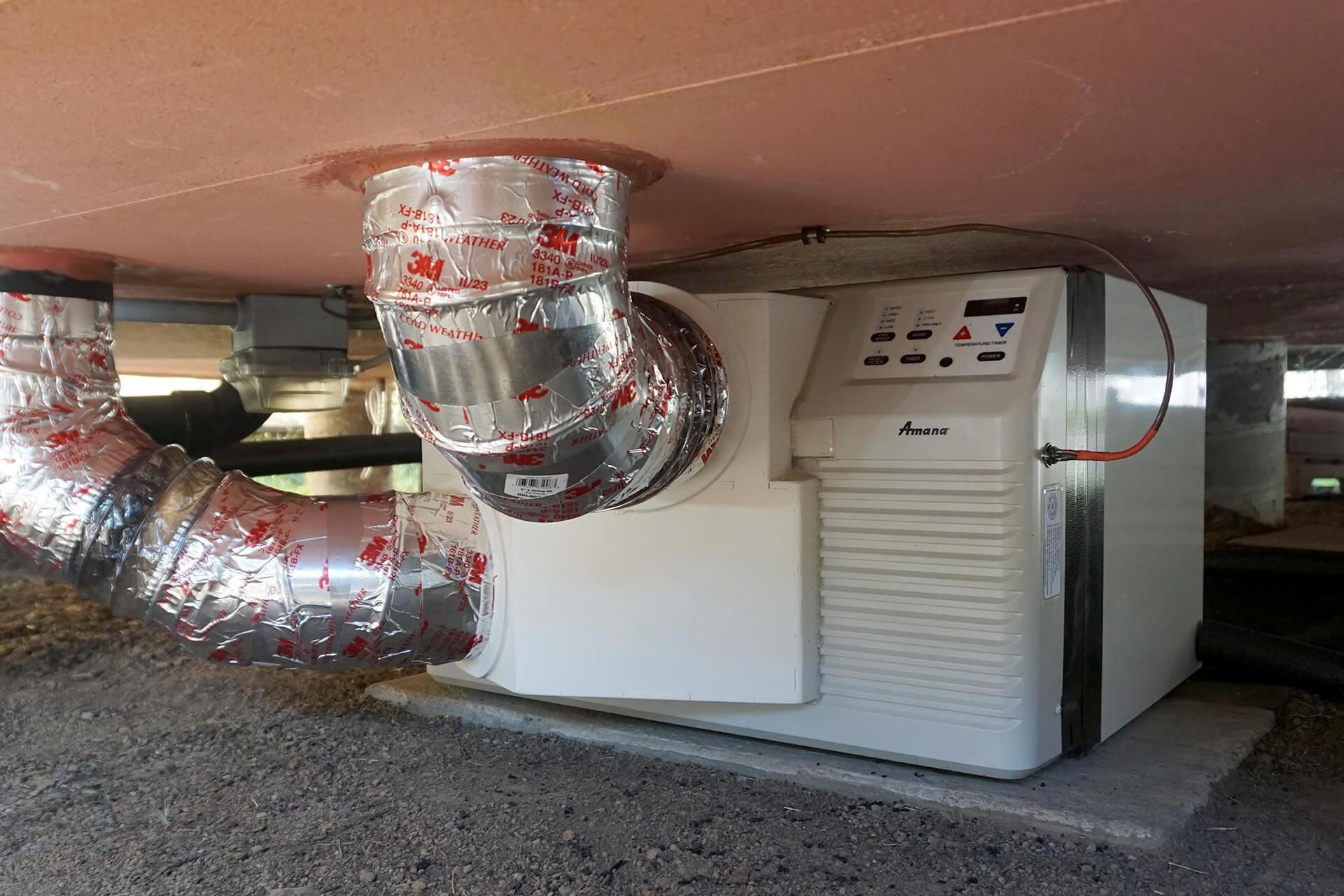

HVAC


Modify a mini PTAC unit. Install it outside and duct it to the inside.

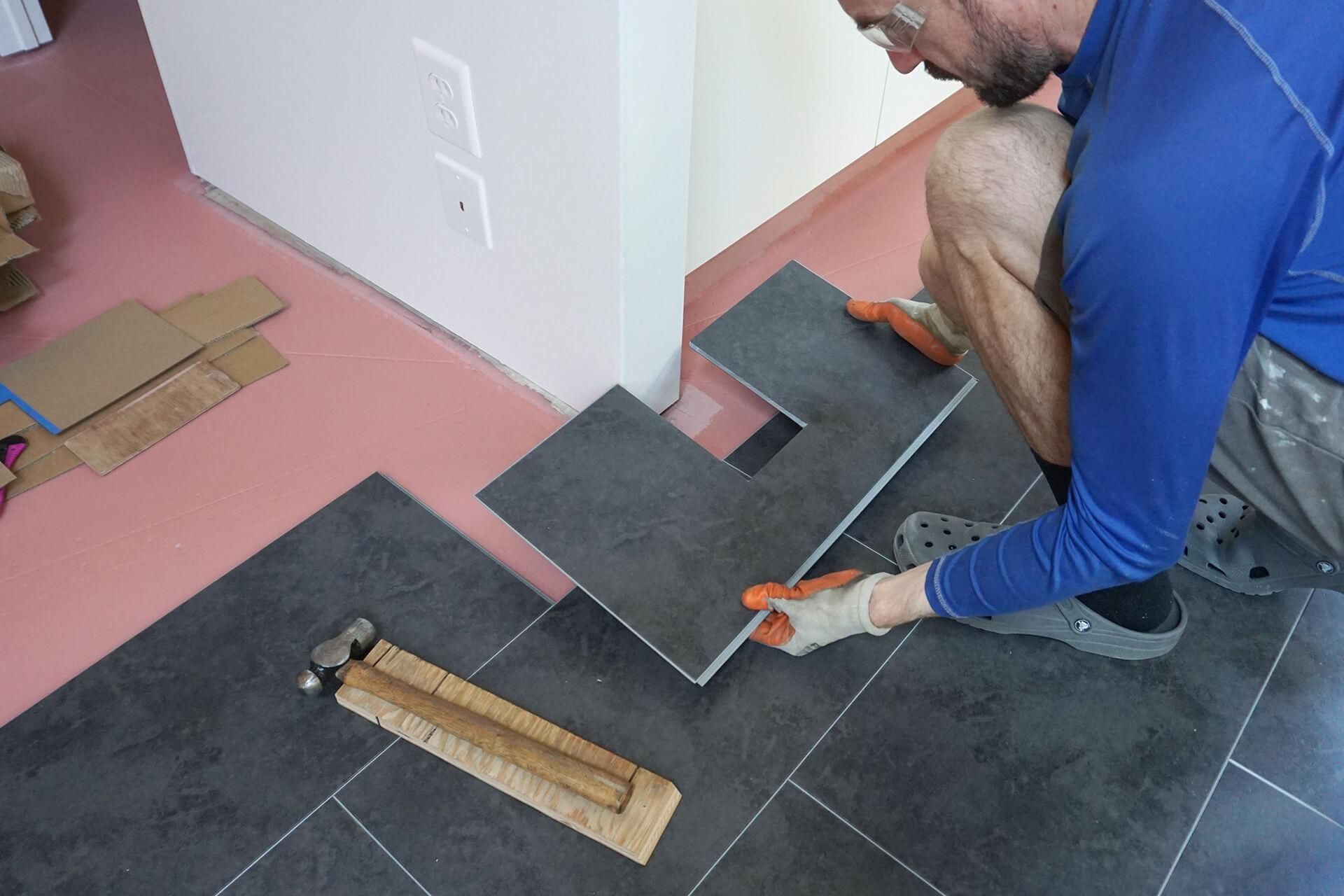

Flooring


Install the uppler flooring, prep the main subfloor, and install the main flooring.

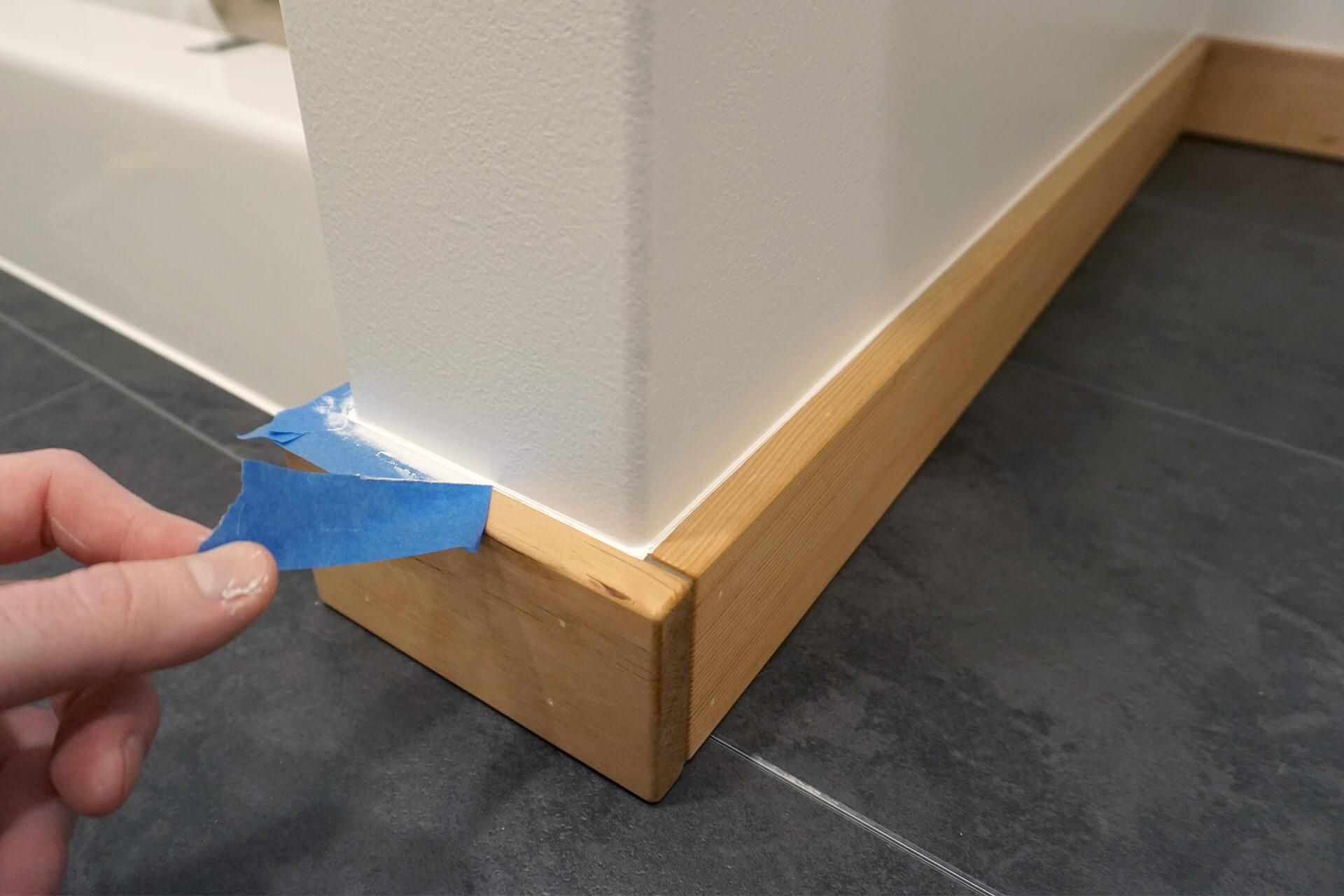

Final Trim


Measure, cut, finish, and install the door casings, baseboards, and panel trim.

Furnishing


Install the toilet, refrigerator, dining table, sofa bed, TV, bed, side tables, and many other smaller items.

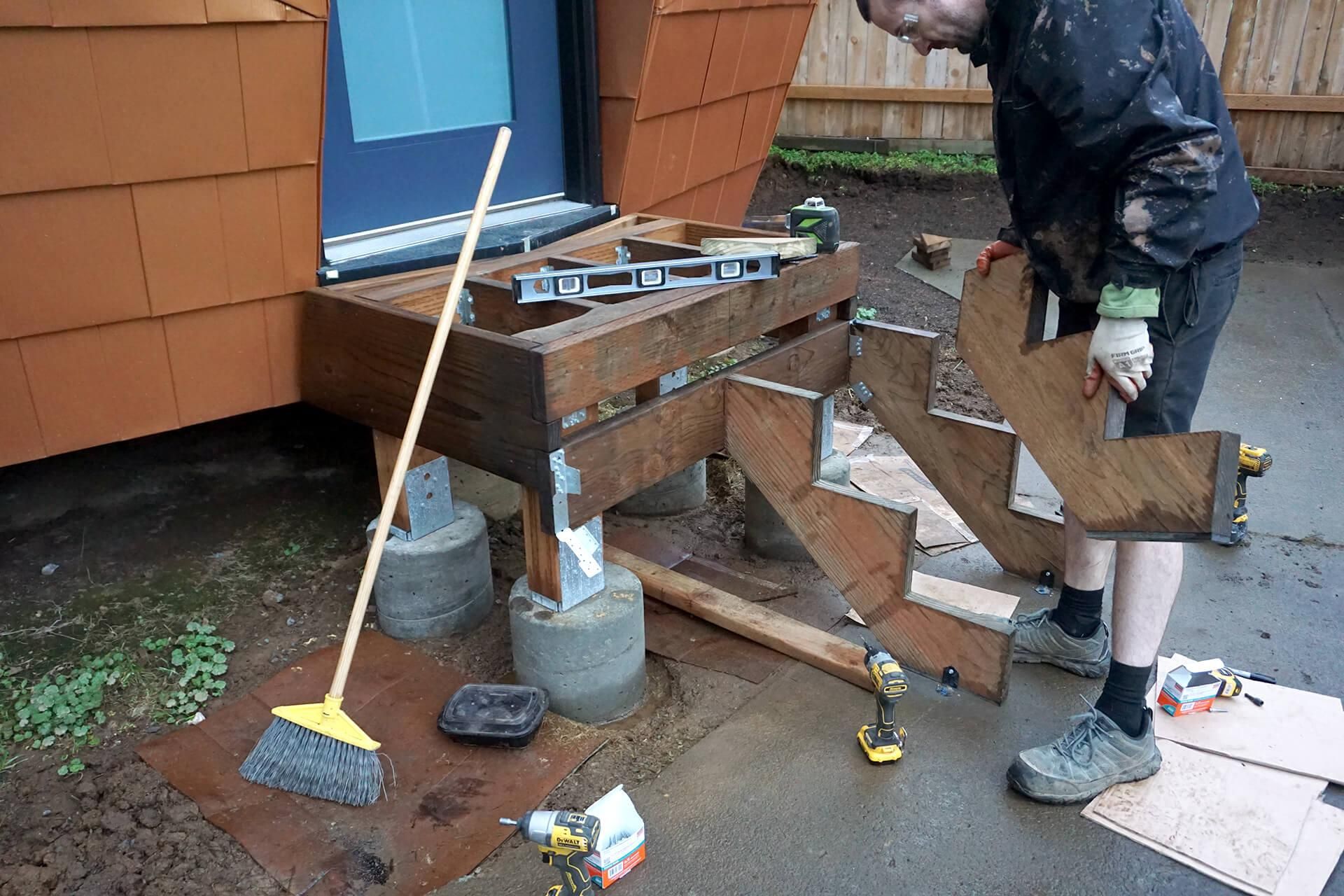

Porch


Make room for the porch, pour the foundation, build the frame, and surface the framework with planks and handrails.

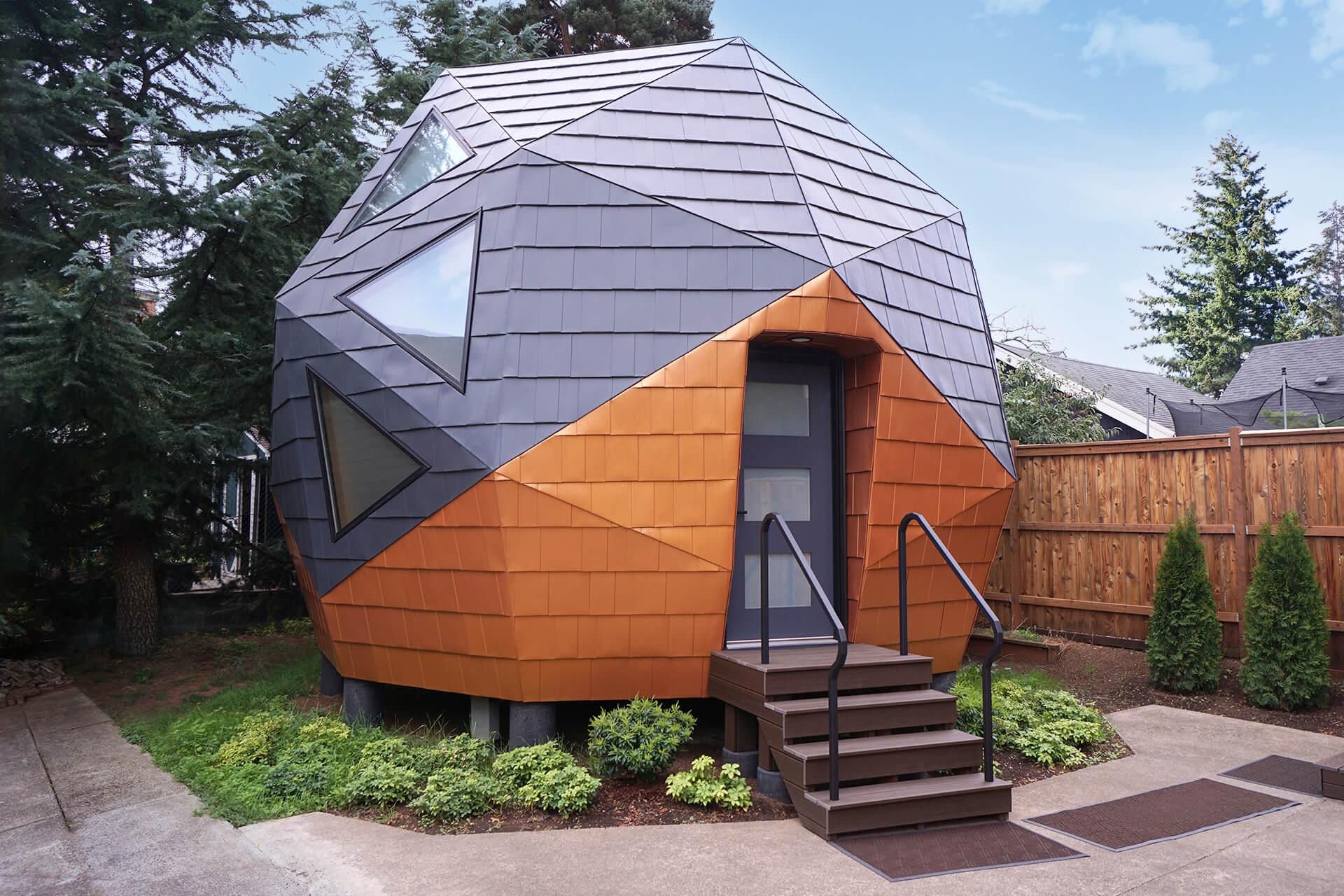

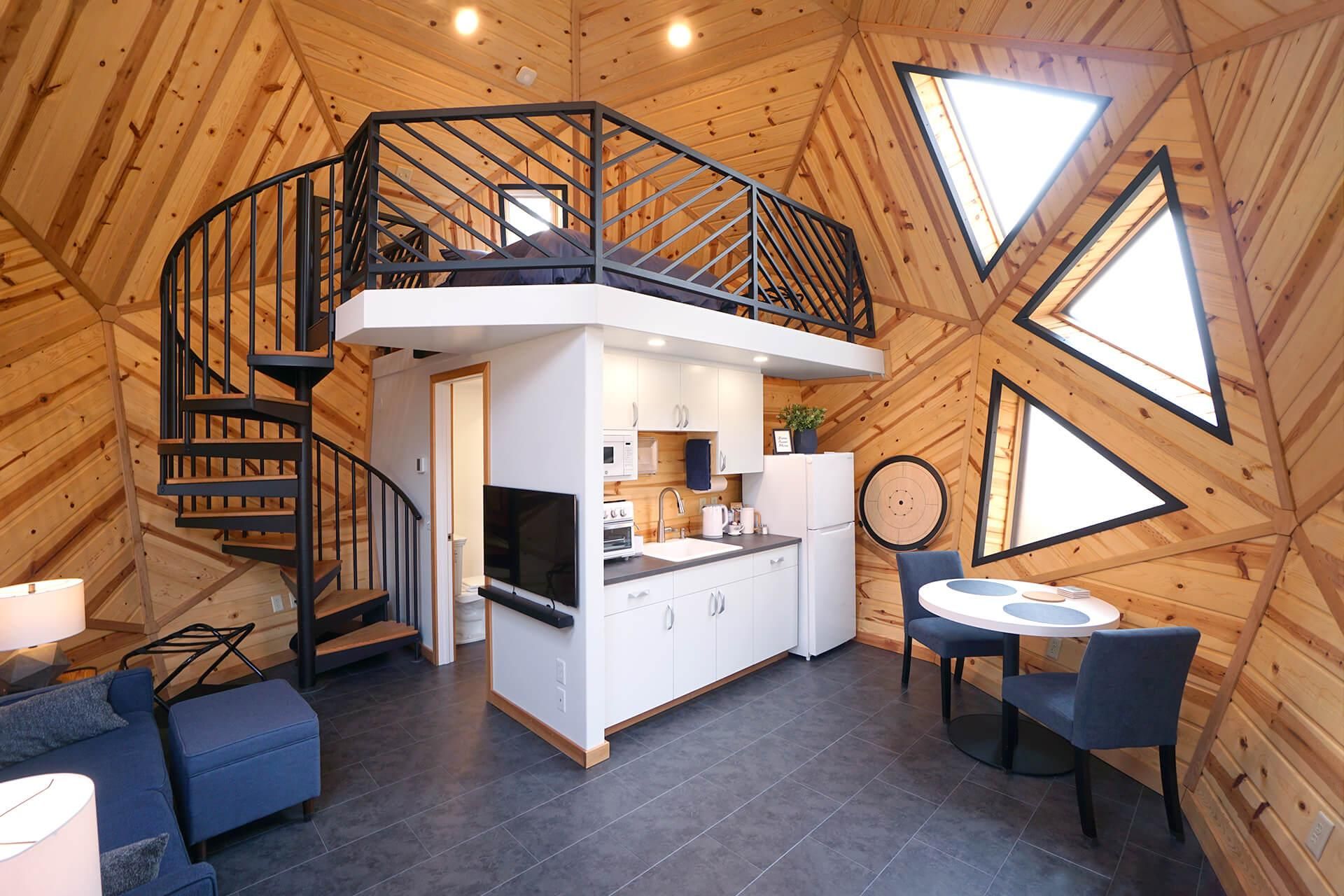

Finished


Landscape and photograph the finished product.

For more photos, info, or to purchase my book please visit DodecaDomes.com.


Thanks for checking out my projects.

-Josh!
